We are building a house
Jul 19, 2020
Updated
Dec 8, 2022
Our weed-covered land is starting to transform. This house project might take a time of seven years in the end. We bought the property in 2019 from the city of Paderborn. Being elegible for buying required us to be on a waiting list for five years. During 2019 we selected the builders, which are Knecht Fertigkeller for the cellar and Haas Fertigbau for the house. Also in 2019 we started to work on the architecture of the house. Now, in July 2020, change is coming!
I´m posting a timeline of images here to document the progress.
The ground The envisioned house The initial measurement The excavation The fine measurement The cellar Power and water supplies Measuring the cellar The house Indoor installations Blower door test Heating Tiles Home office Close to the finish Moving into the house Green rooftops The last parts of the scaffolding have been removed Planting a beech hedge
19 Apr, 2019: Emil is running across a weed field. This is the place where we are going to build our house.

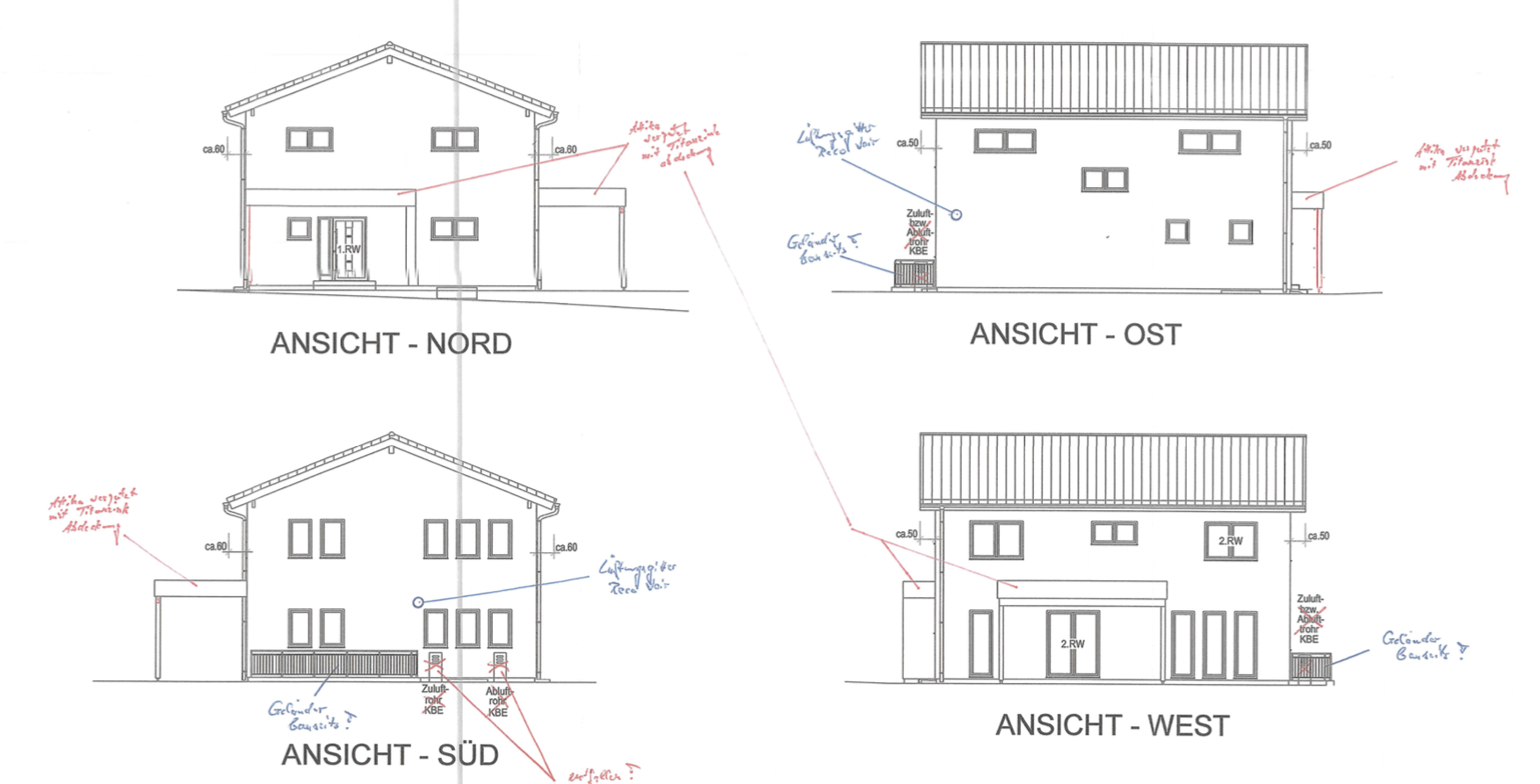

Oct 2019 - Apr 2020: Architecture work, some impressions.
Jul 6, 2020: We are in Falkenberg to decide the complete interior design of the house – within a duration of two days. Our builder, Haas, is taking care of accomodations and after the first day of work we are enjoying dinner in the beer garden of our hotel.

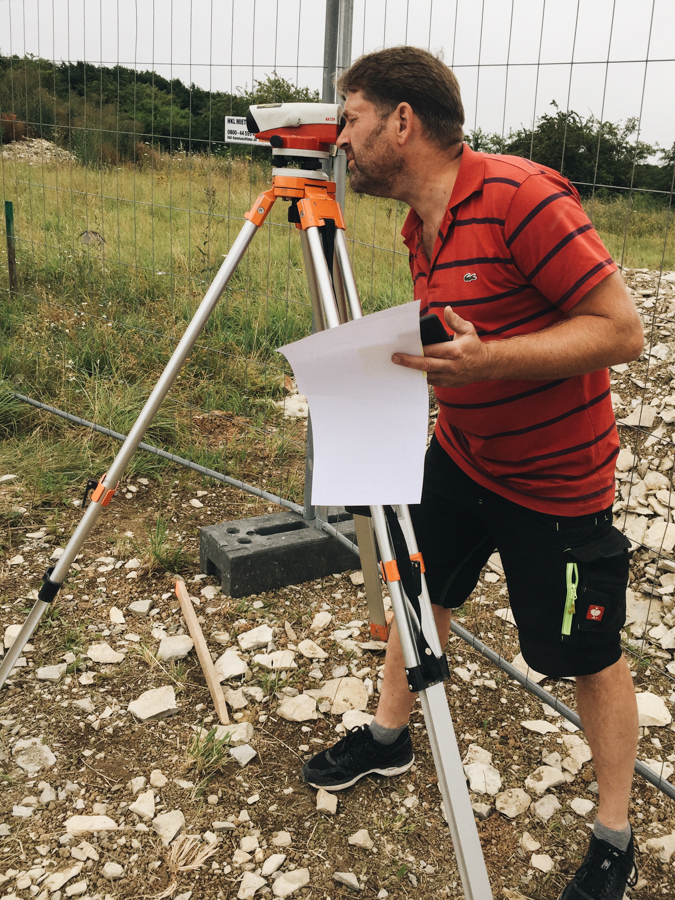

Jul 14, 2020: My brother is doing the measurements to prepare the underground engineering.

Jul 19, 2020: Heavy machinery is brought into place to do the excavation work. Our partner here is Andre Westermann .

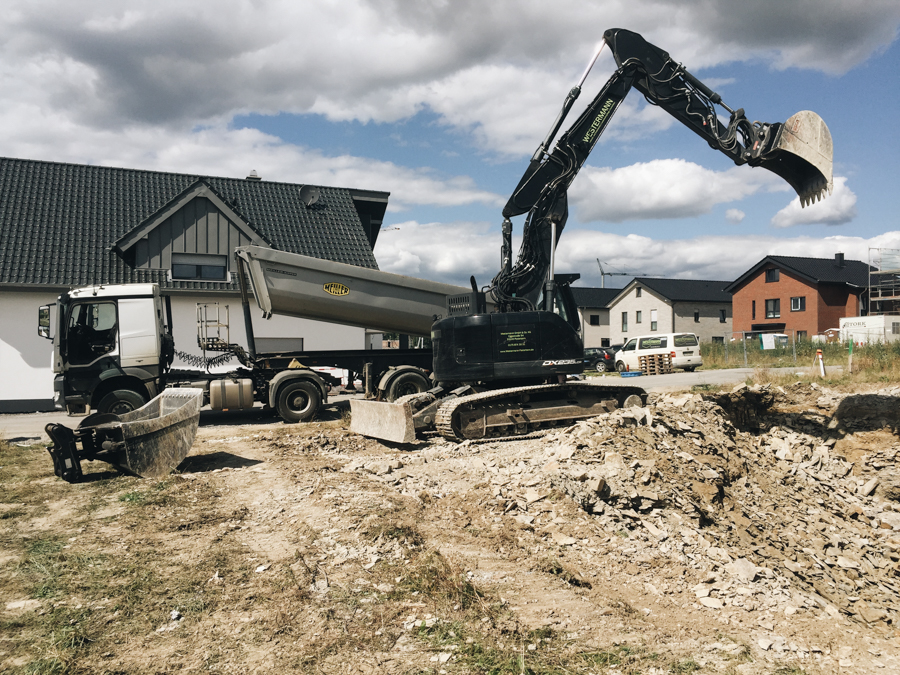

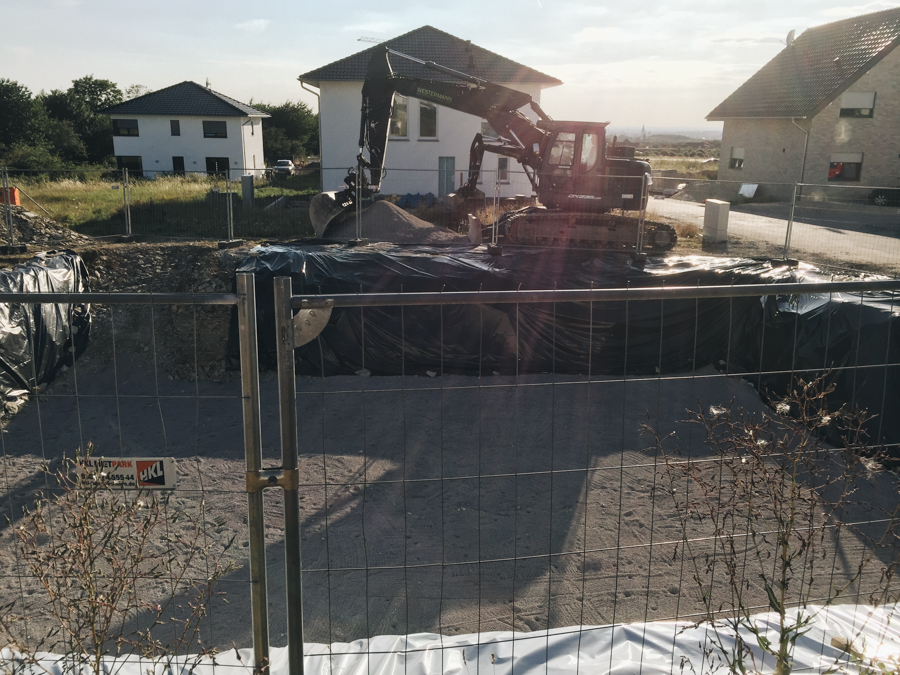

Jul 21, 2020: Day one of excavation work. Our ground is rock and stones.

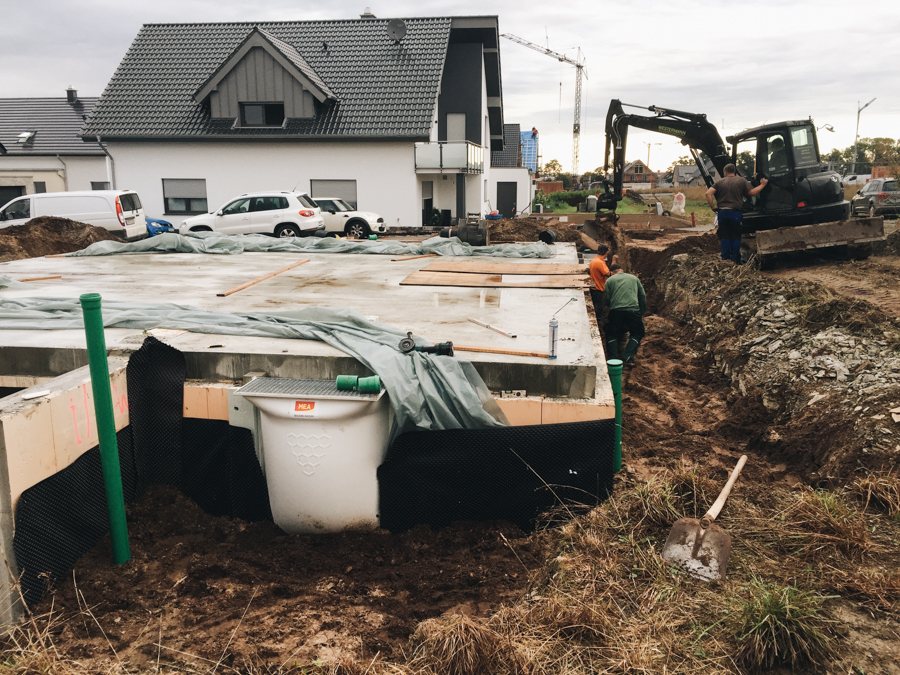

Jul 22, 2020: After only two days the excavation work is completed.

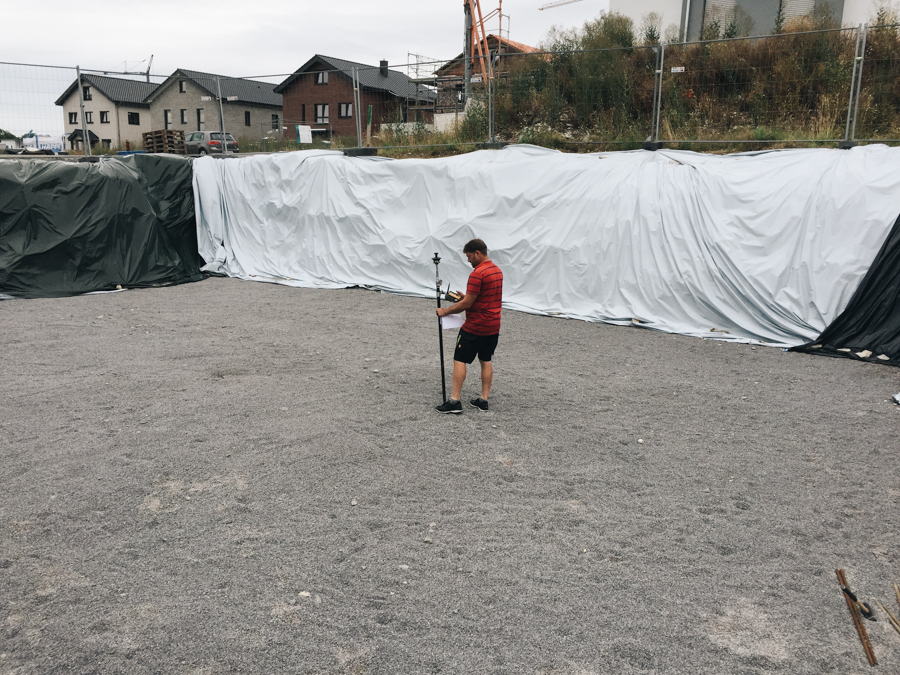

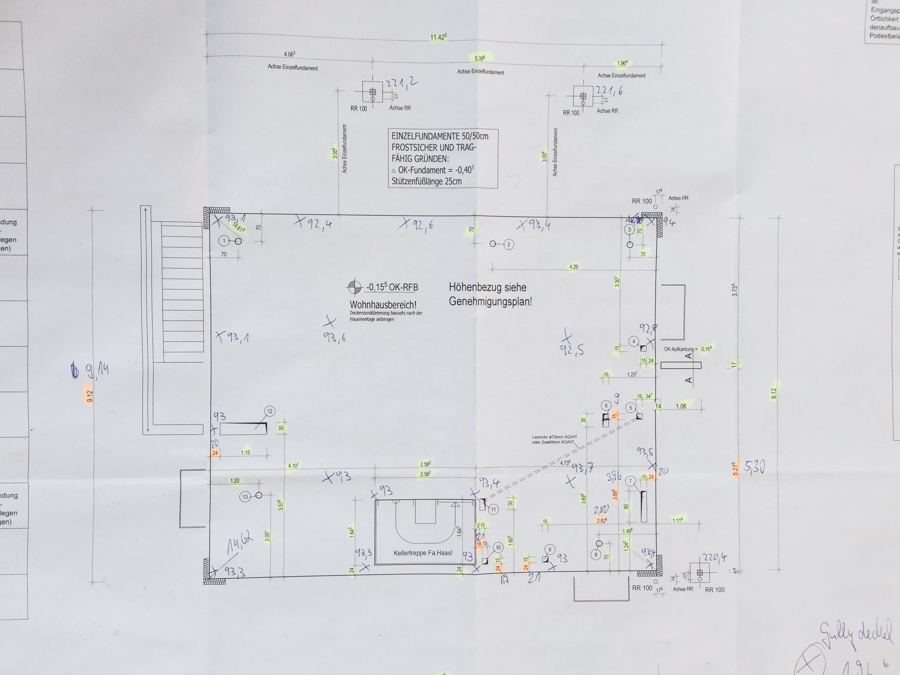

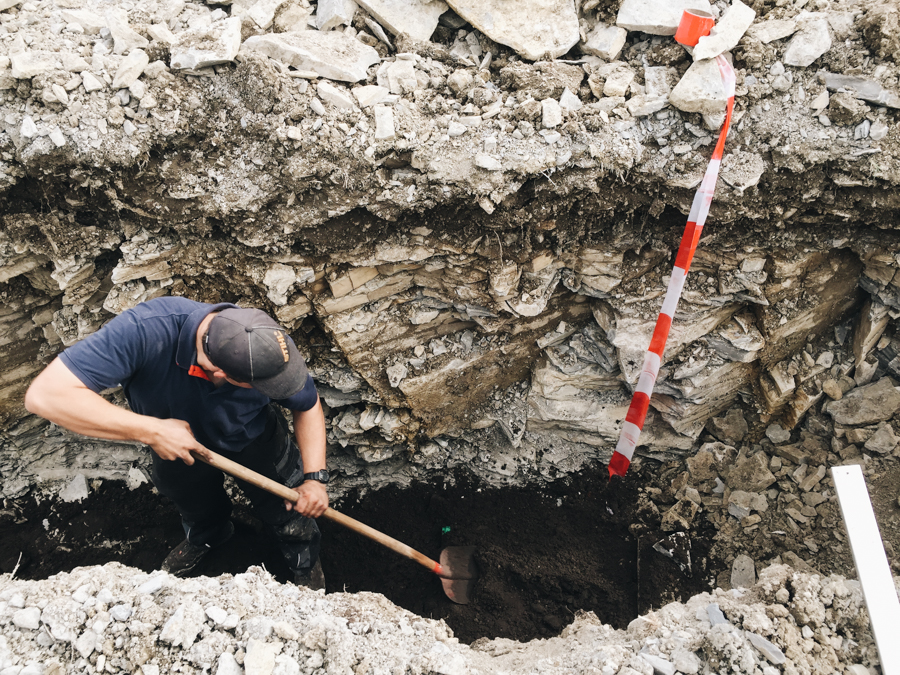

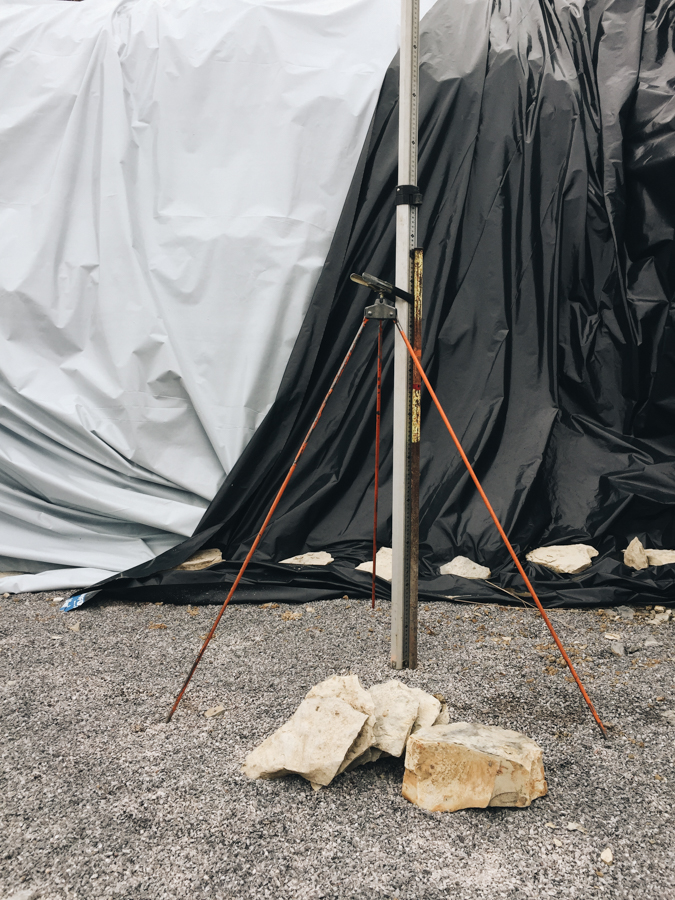

Jul 27, 2020: My brother is doing the fine measurements. We have a problem. The ground is so solid that we cannot bring in the steel posts properly. They go only as deep that it holds like spit-glued. Fortunately our cellar builder is capable enough and willing to go ahead with it.

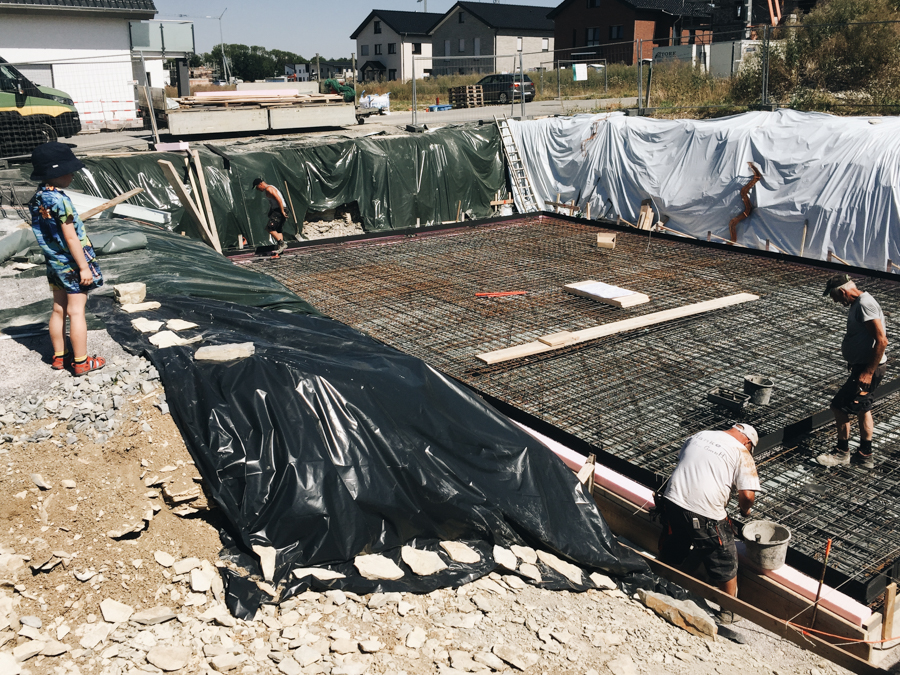

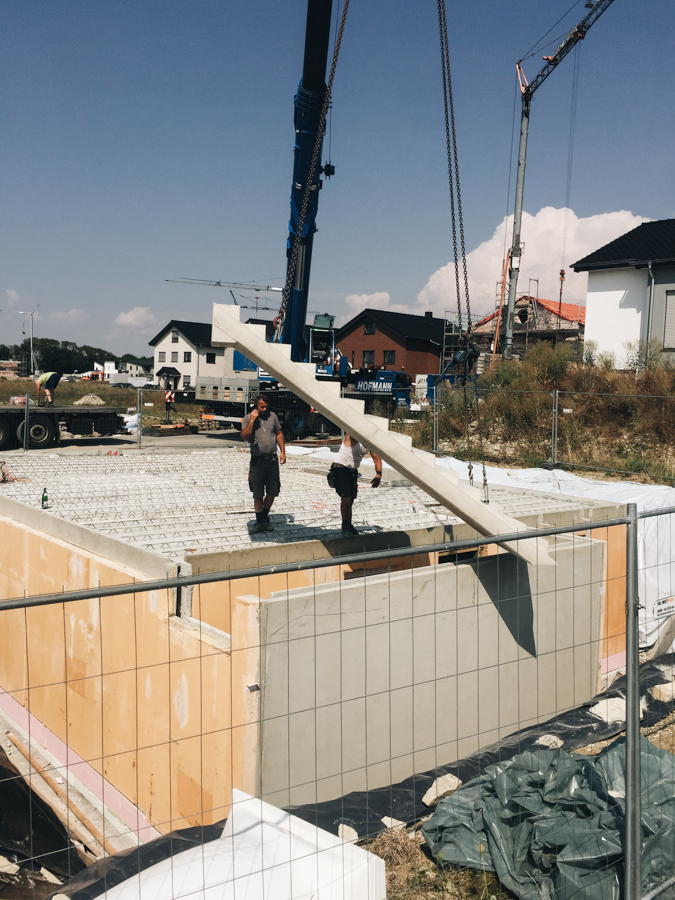

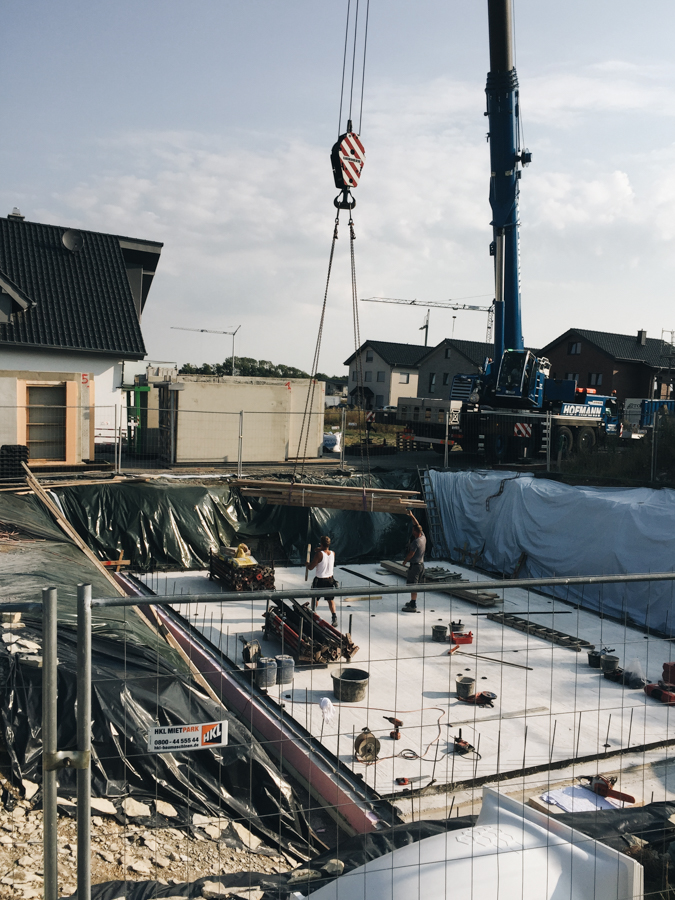

Aug 6, 2020: The cellar builders start their hard work. The temperature is above 30 °C. At the first day it´s formwork and bringing in the steel. Three men are drinking 15 bottles of water during that day.

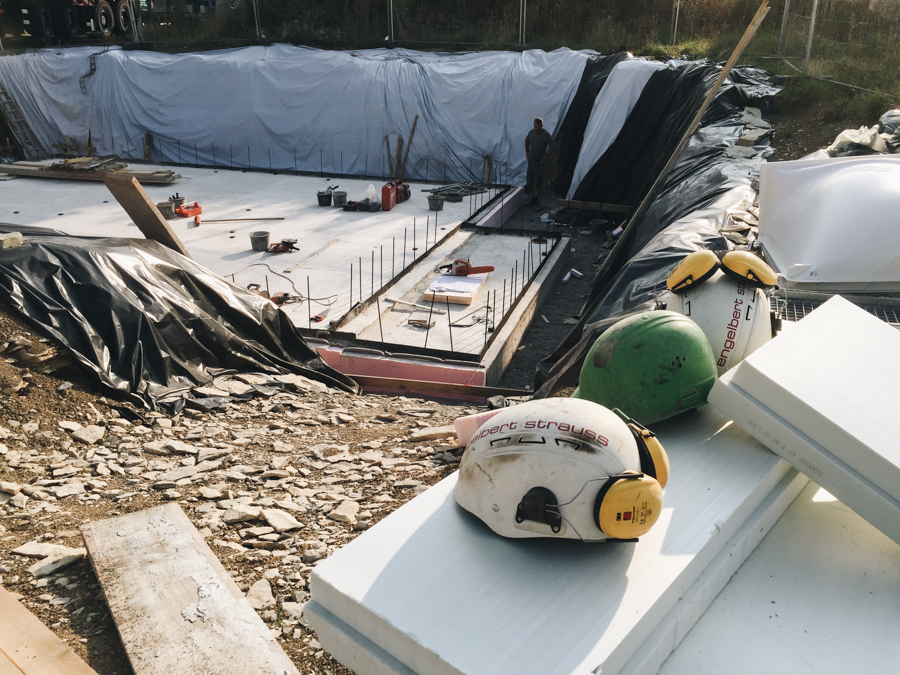

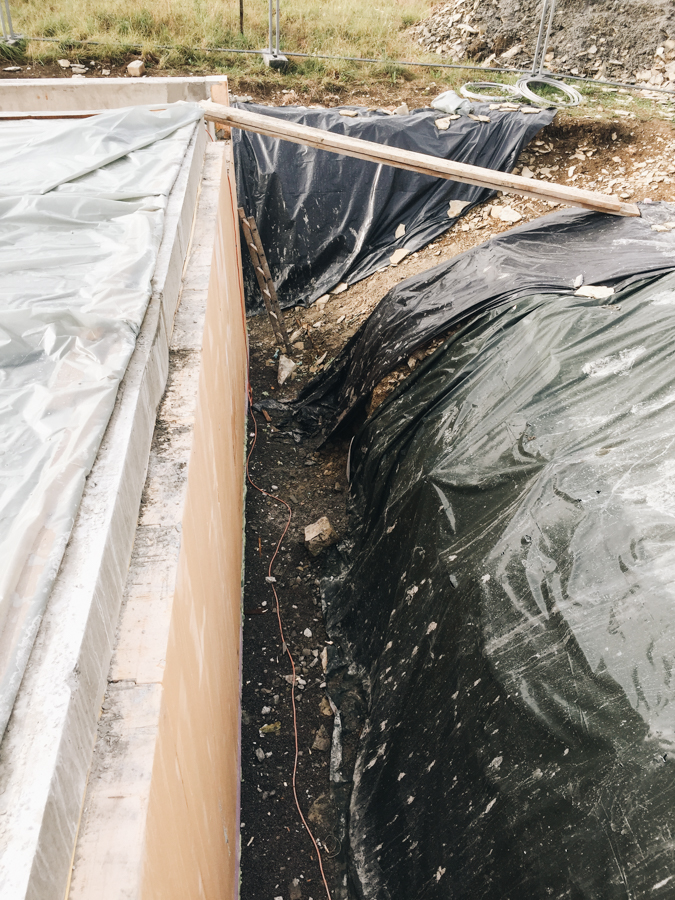

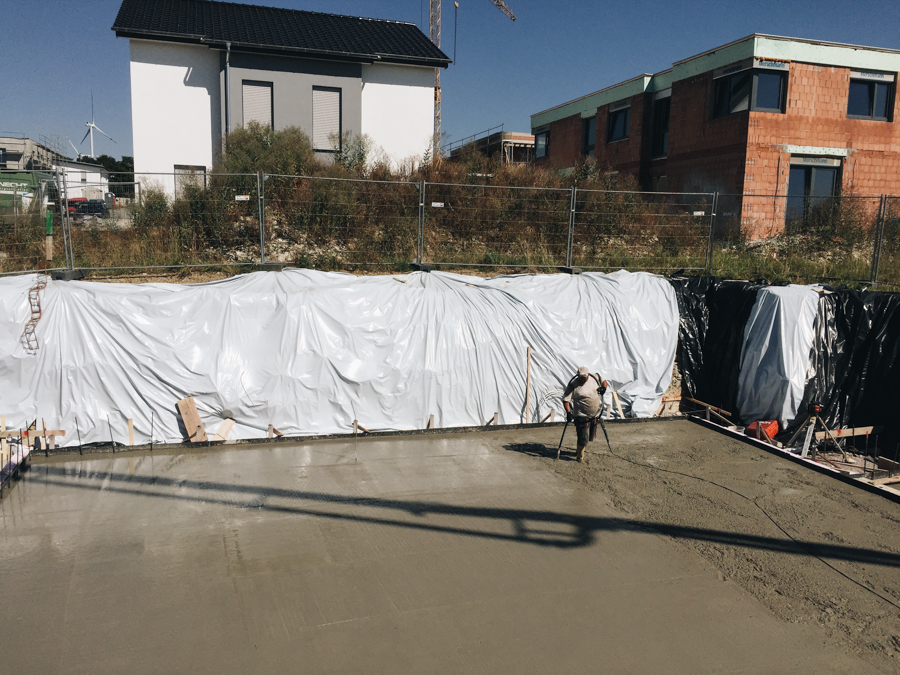

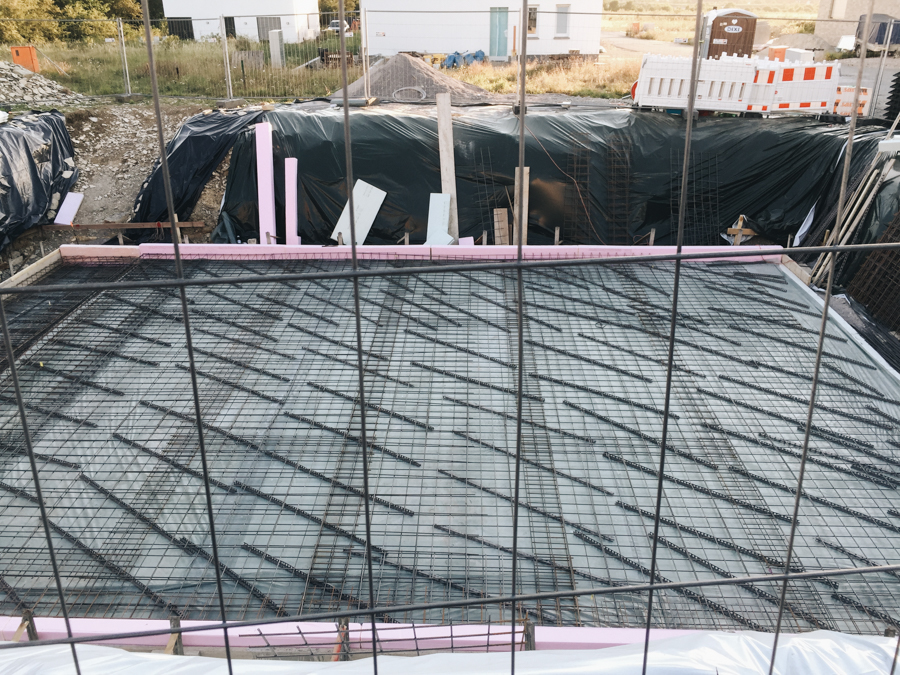

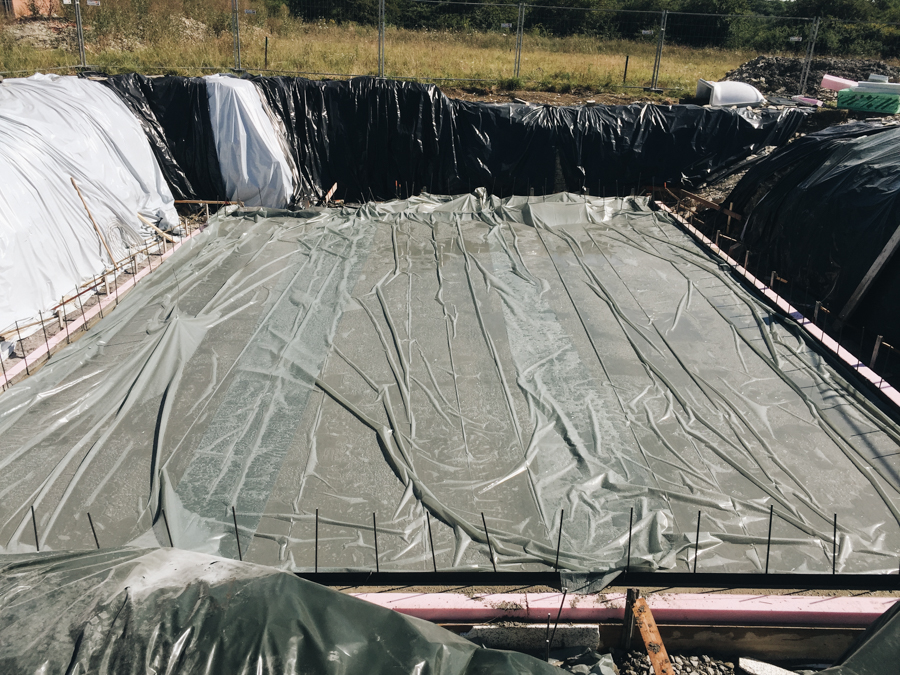

Aug 7, 2020: The basement plate preparation is ready for the concreting. I have hired a construction expert to help me with the acceptance of the delivered results. Before the concreting starts, he wants to see the steel. The expert is very satisfied with the good quality of the work and of course – I´m glad too! Finally it was the right decision to go with Knecht as the cellar builder. The three men, despite the heat of 33 °C in the afternoon, seem to work without any resting. I can only help them with providing water to drink, a bit of coffee, and some food. I think they earned their weekend well. Because of the heat they are covering the new basement plate with film, so that it doesn´t build out cracks during the hardening period. Next week they are going to finalize the cellar.

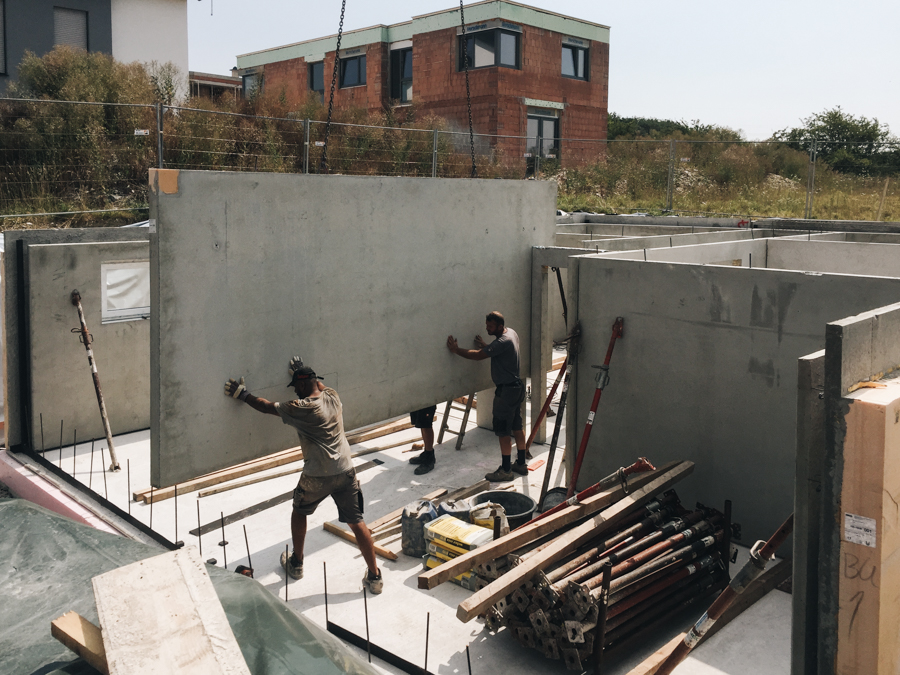

Aug 11, 2020, early morning: The silence before the storm. The men will erect the cellar today.

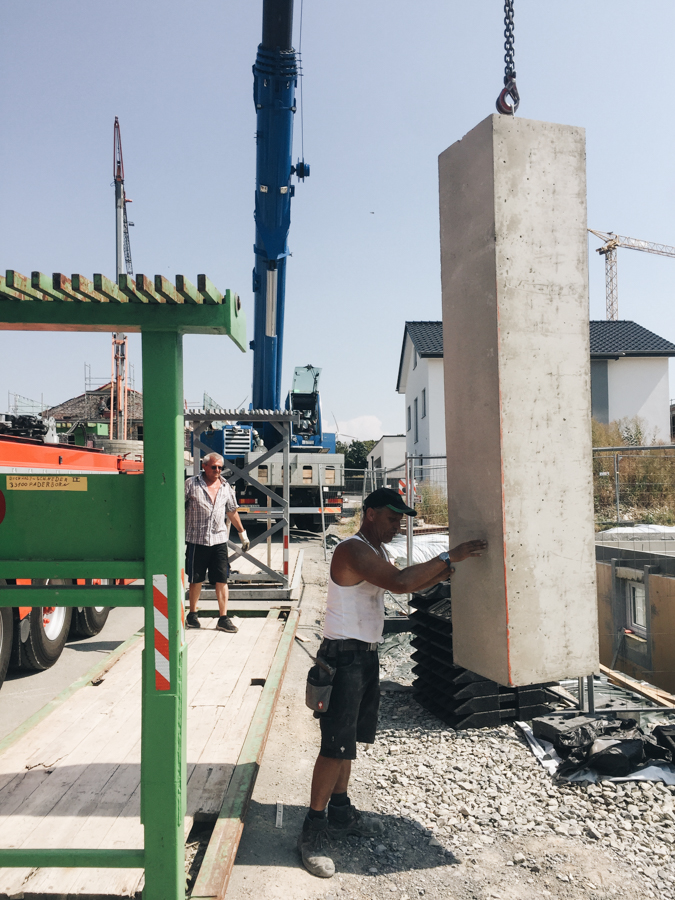

Aug 11, 2020, early morning: The work starts

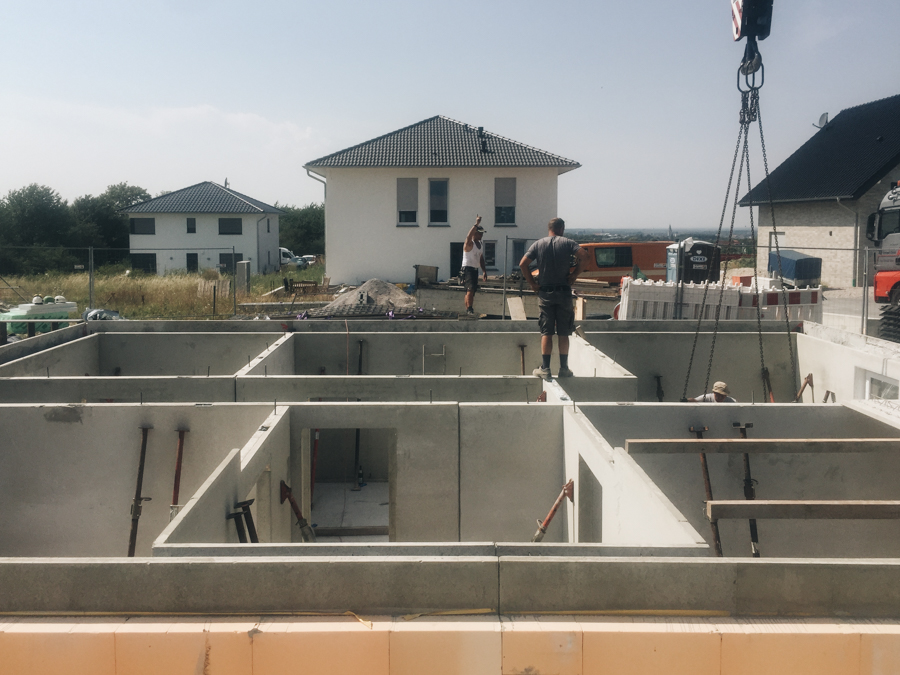

Aug 11, 2020 before noon: The cellar is visible
Aug 11, 2020, afternoon: Bringing the last items into place
Aug 11, 2020, afternoon: The stairs are the last piece to assemble. The men are finishing their work for today.

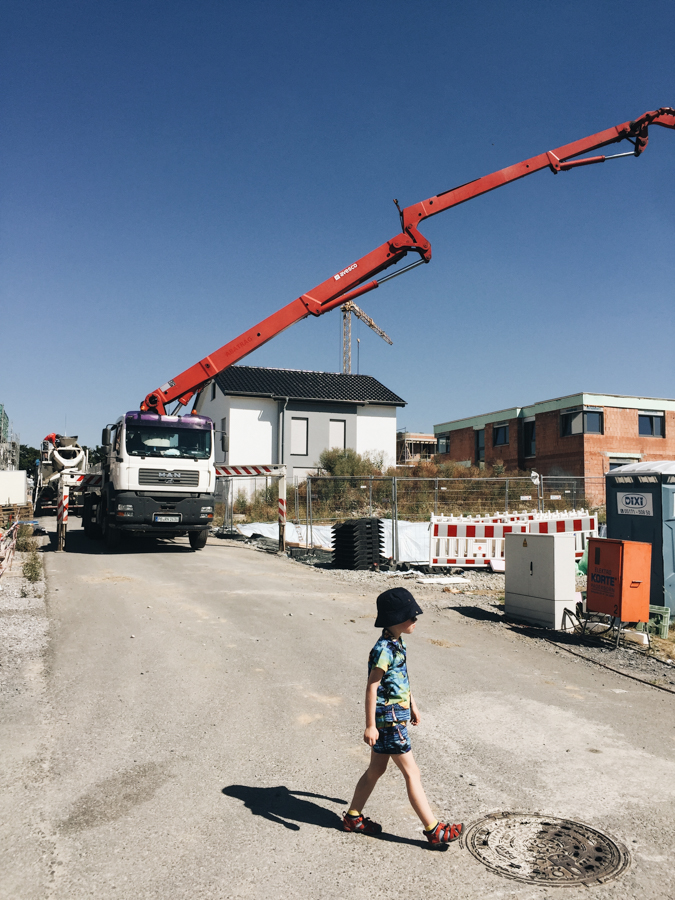

Aug 13, 2020, early morning: Concreting the ceiling of the cellar.

Aug 28 to Sep 1, 2020: Filling up the workrooms and connecting to the sewerage system.

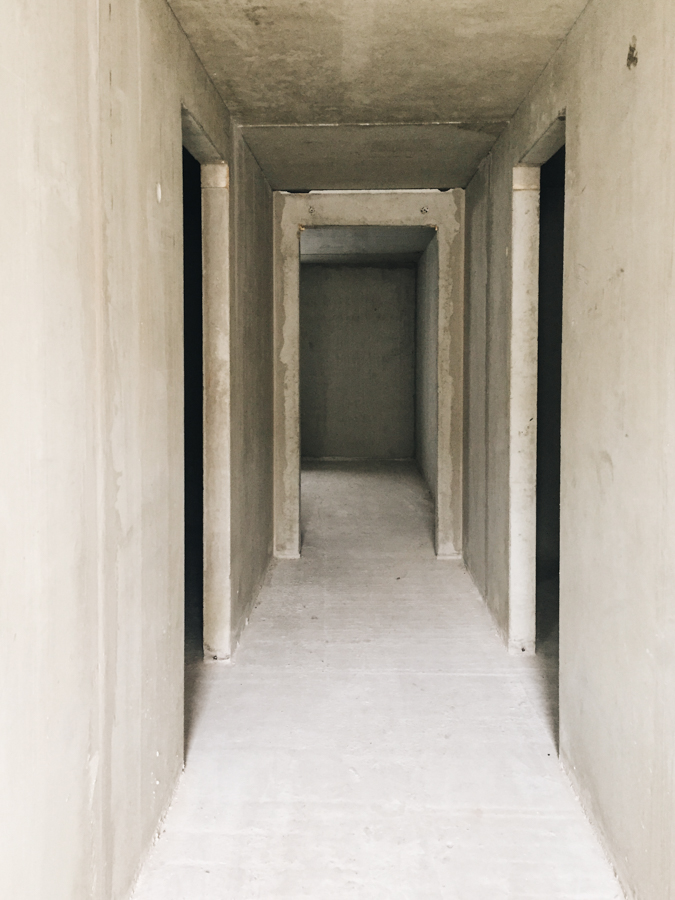

Sep 3, 2020: The cellar is ready.

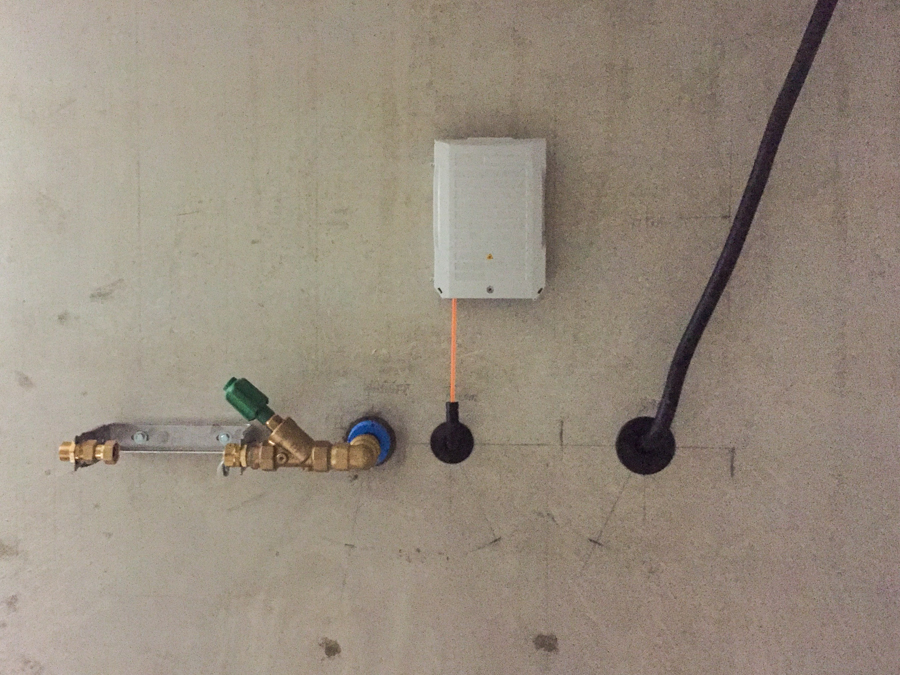

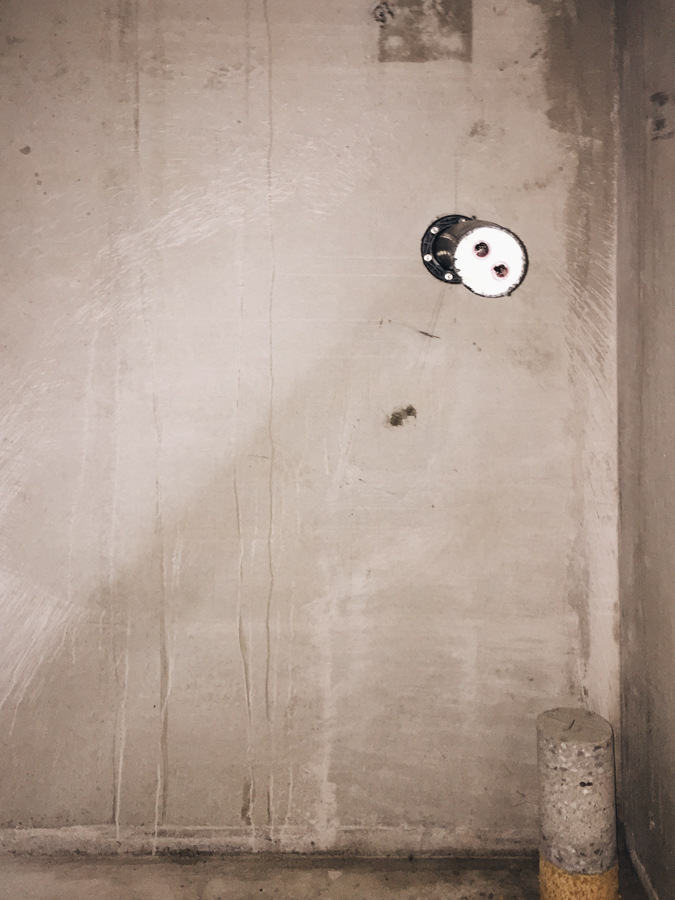

Sep 15 to Sep 16, 2020: Power and water supplies are provided

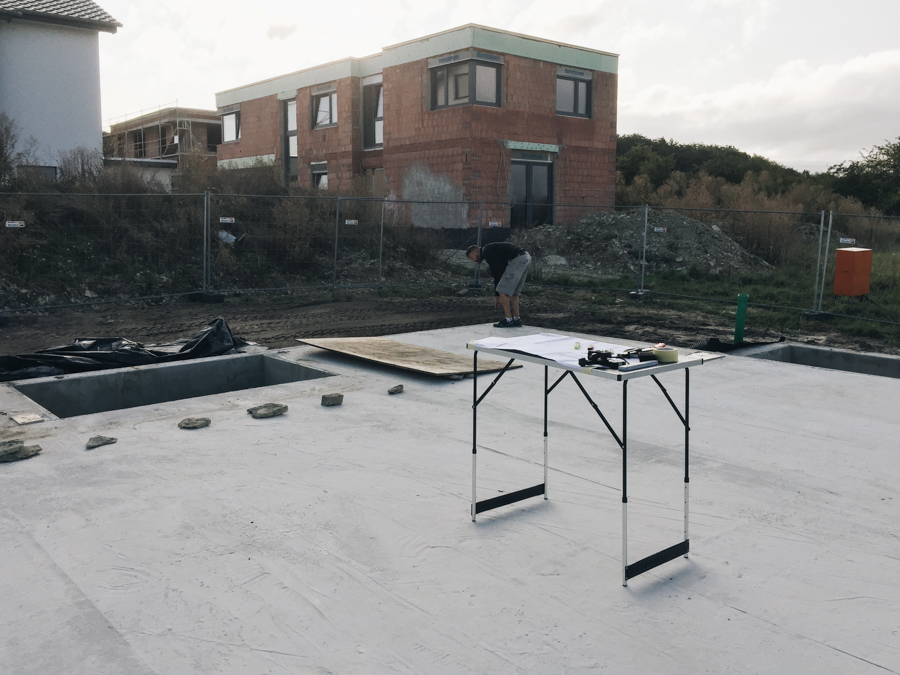

Sep 18, 2020: Measuring if the cellar is within the tolerance to place the house on top if it

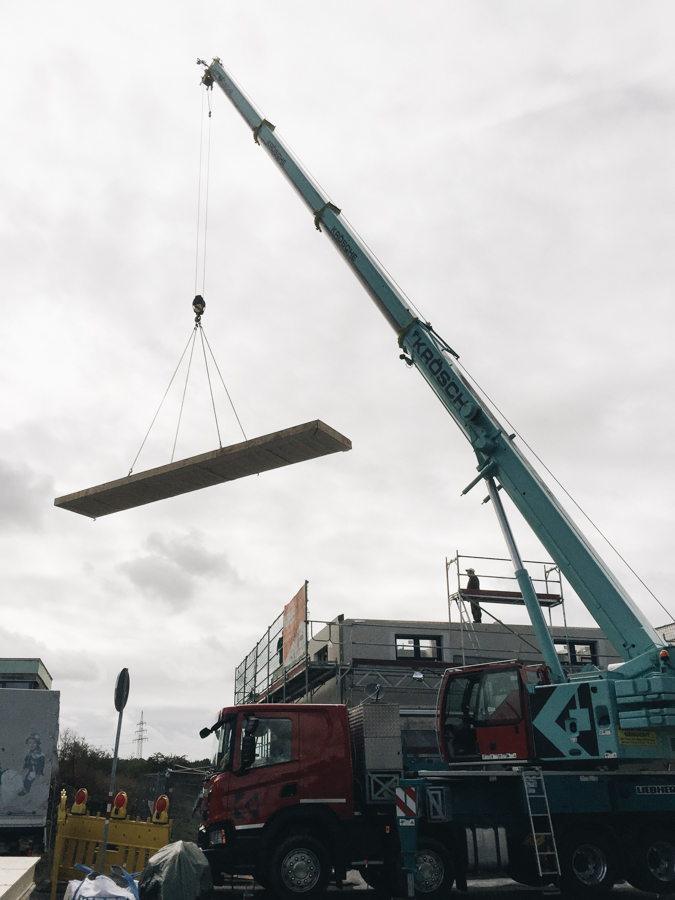

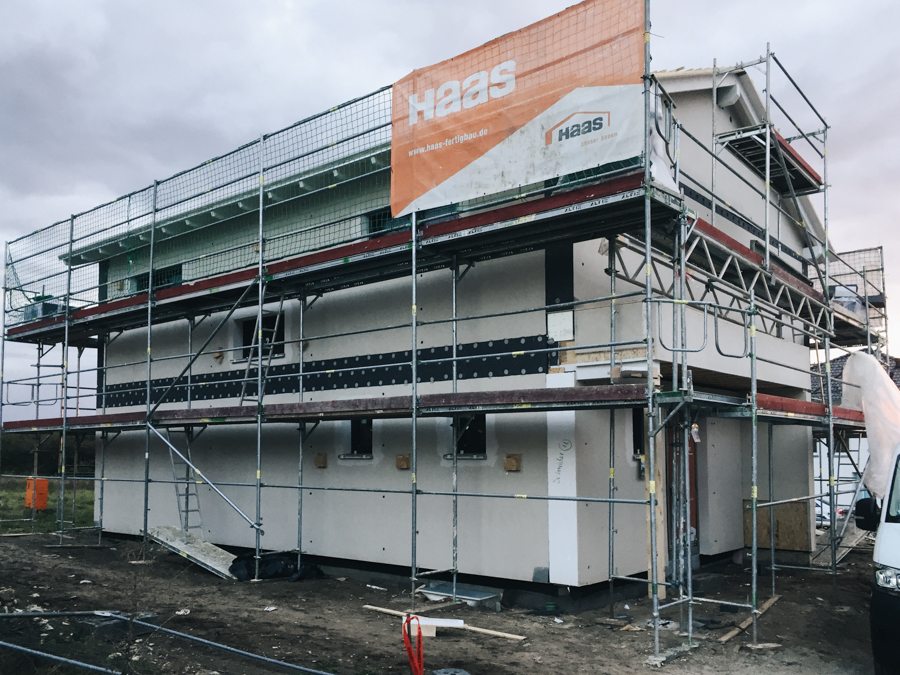

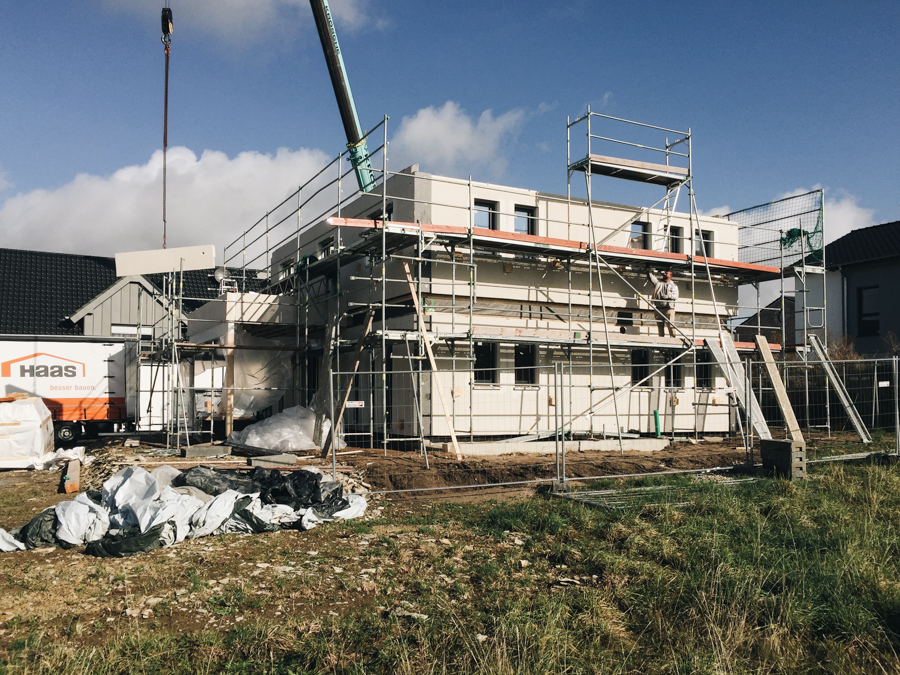

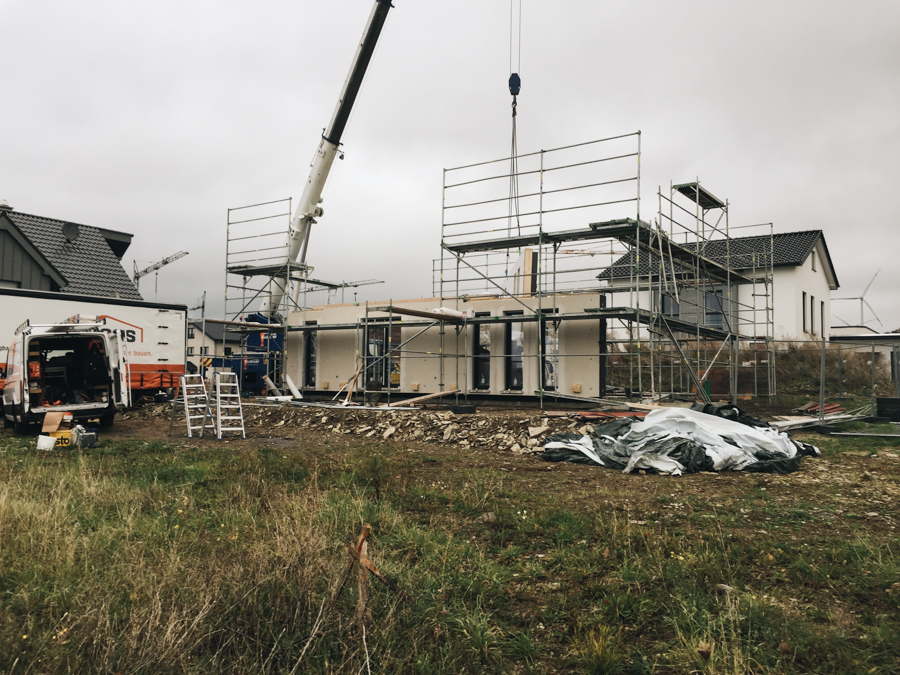

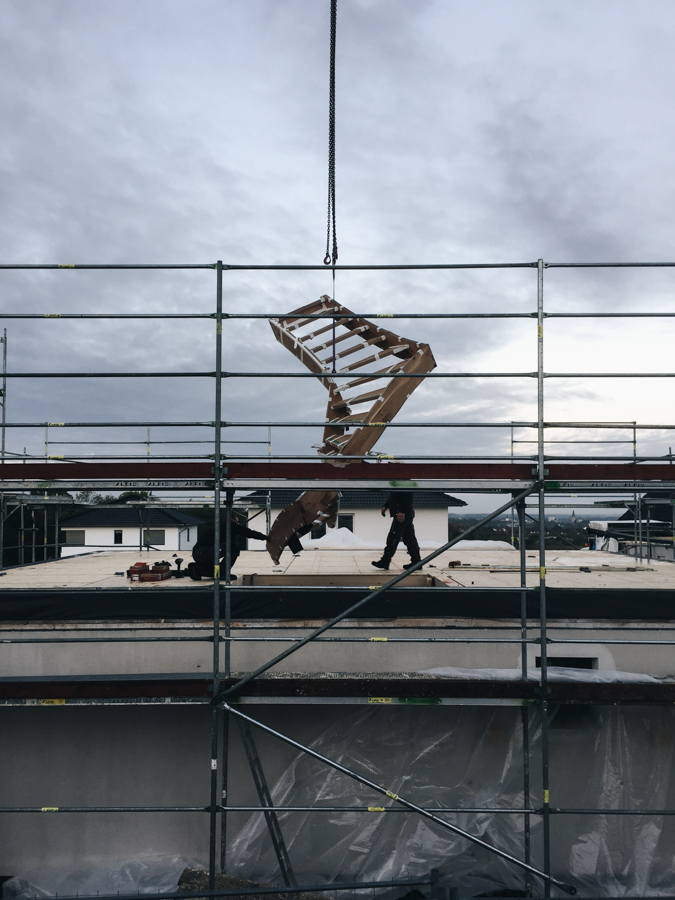

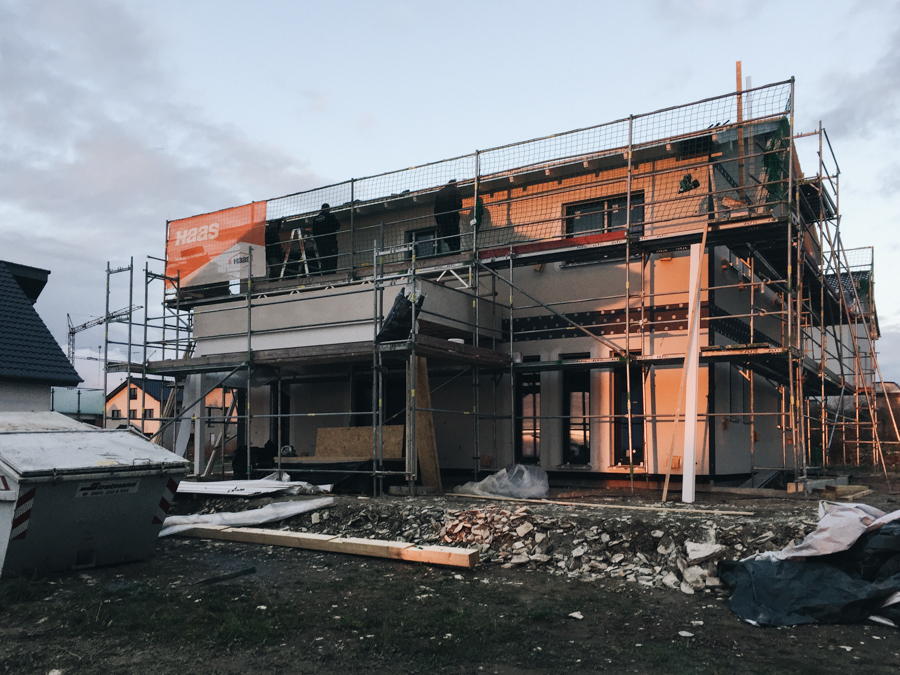

Oct 7, 2020: The house will be erected in this week. At first there is only the scaffolding – no house. Then, the first wall …

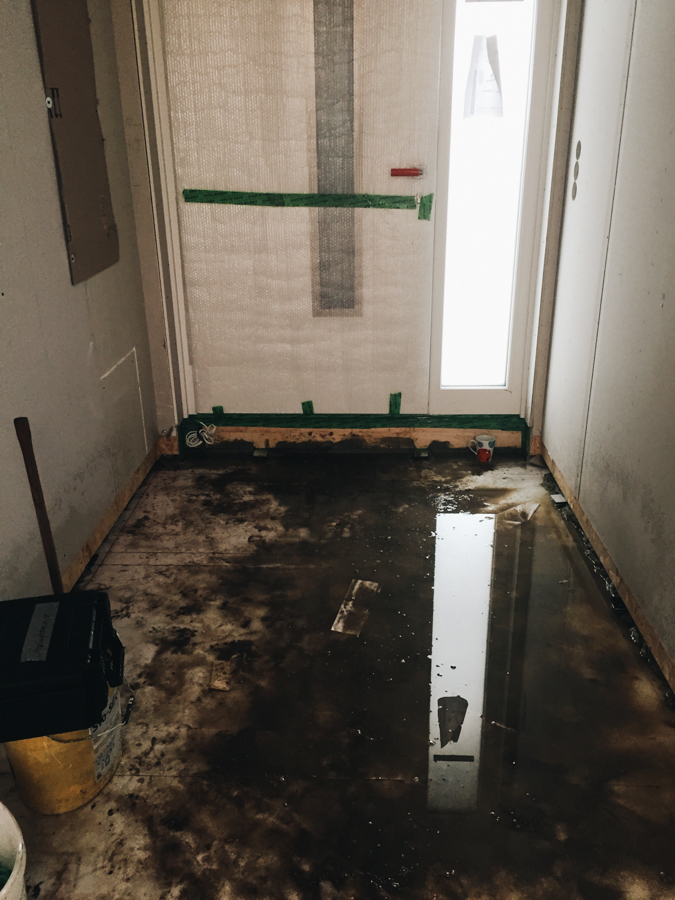

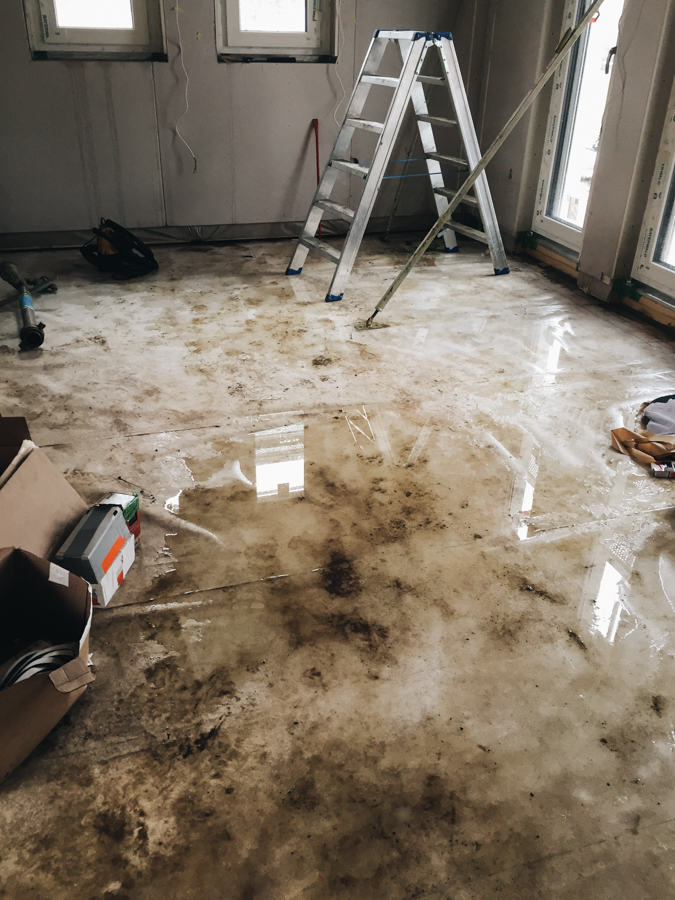

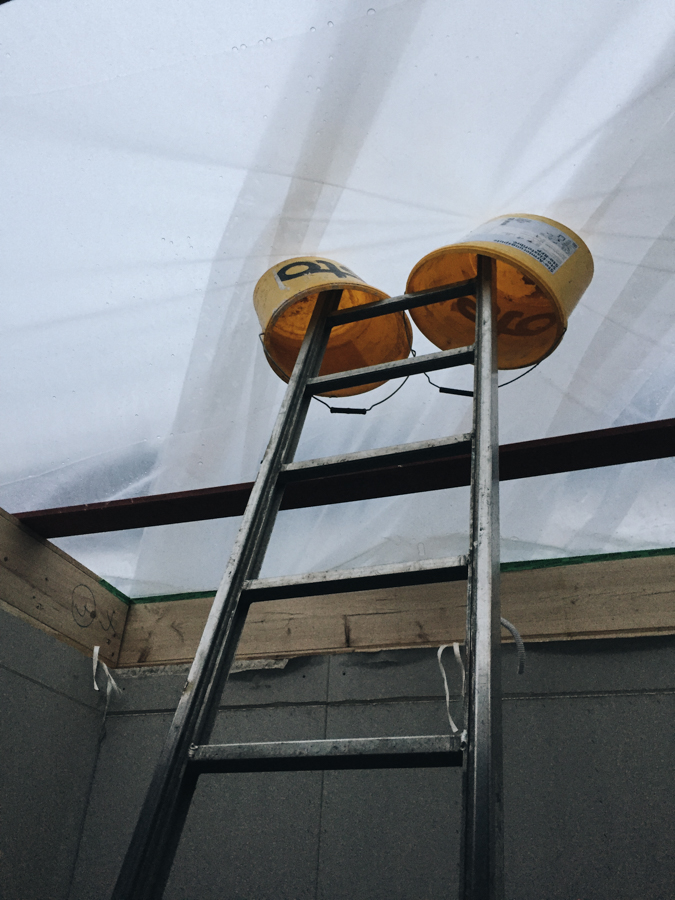

… then it begins to rain. The ground floor is ready, but no roof ontop. We try to protect the house with foil, but the water is everywhere.
The work cannot proceed on Oct 8 due to the rain. Only Oct 9, 2020, a Friday, the work can be finished.

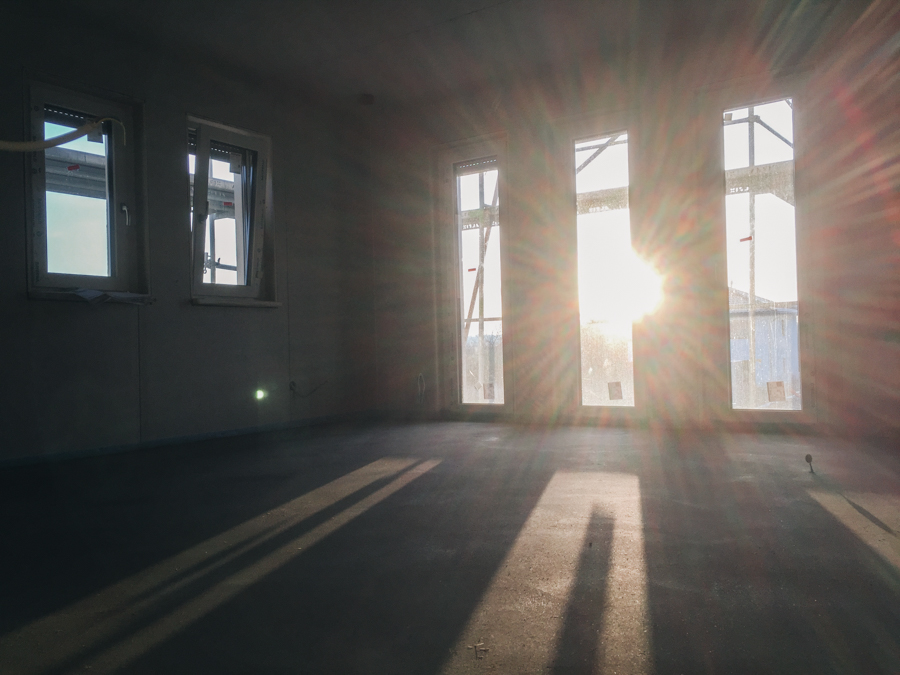

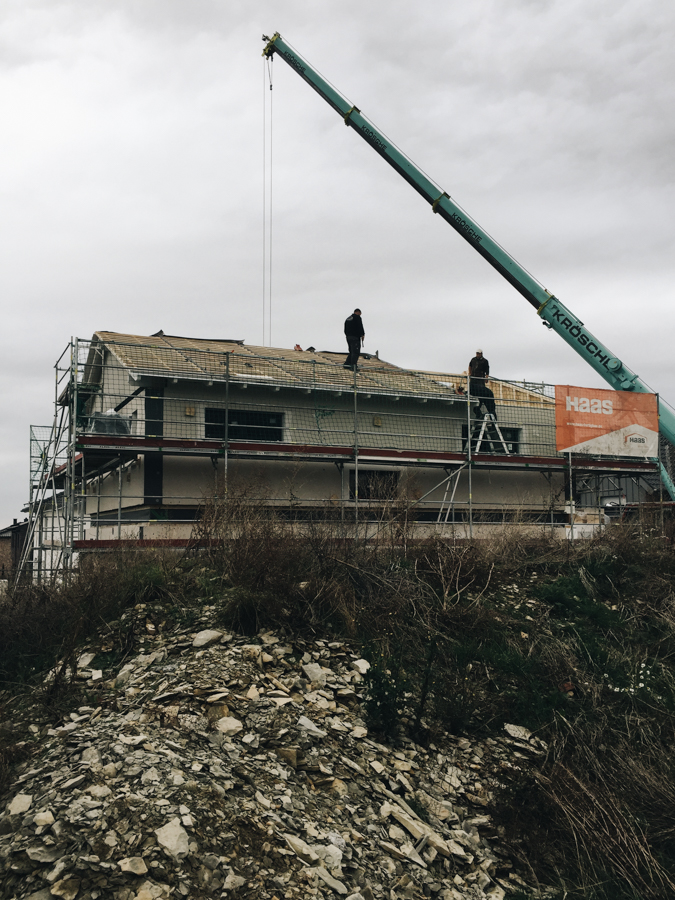

Finally, on Friday afternoon, there is a house with a roof. Thankfully, the craftsmen didn´t leave until this part of the work was completed.

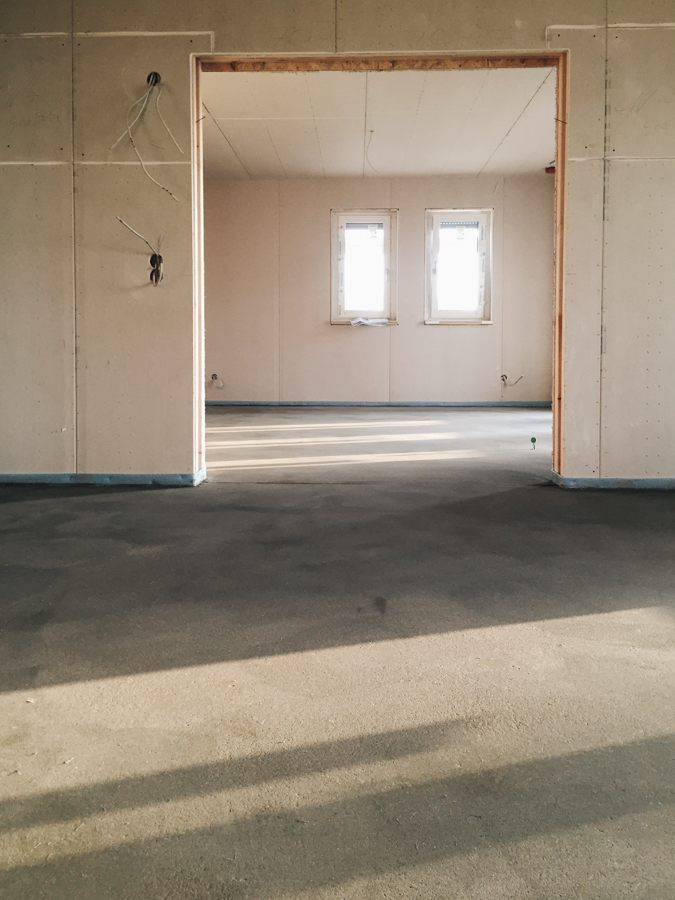

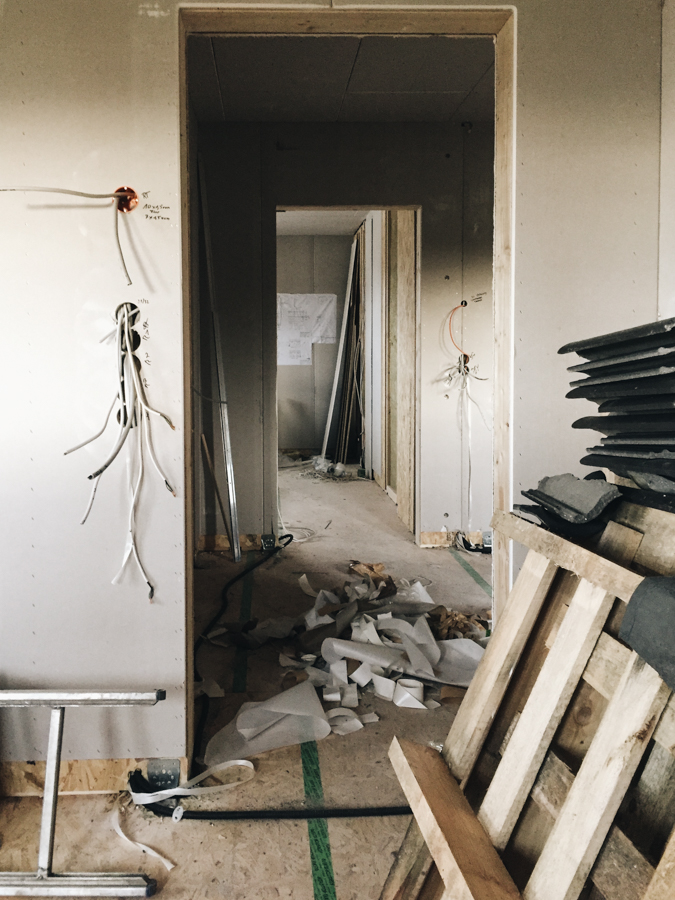

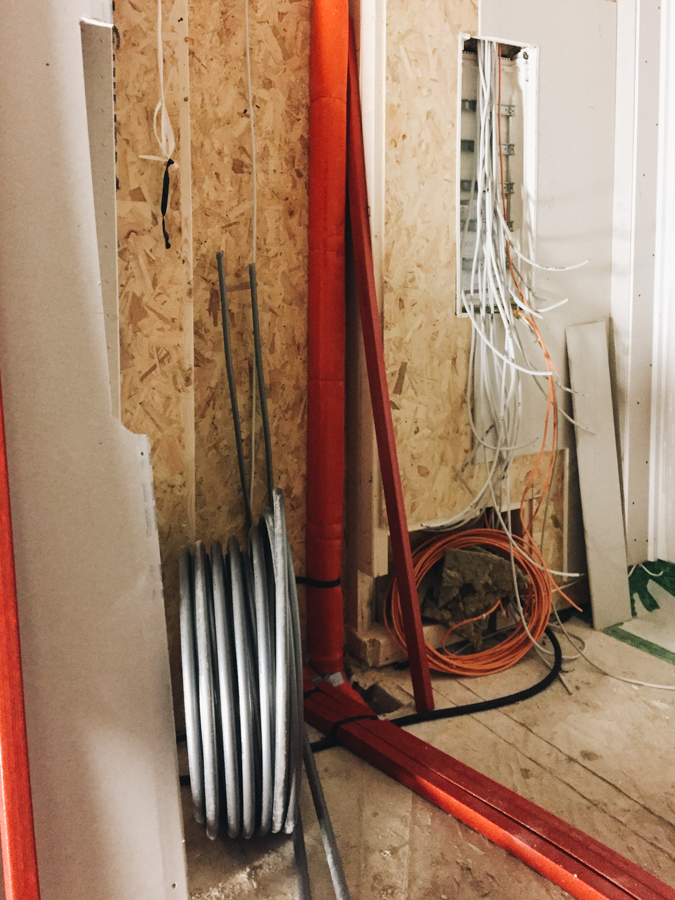

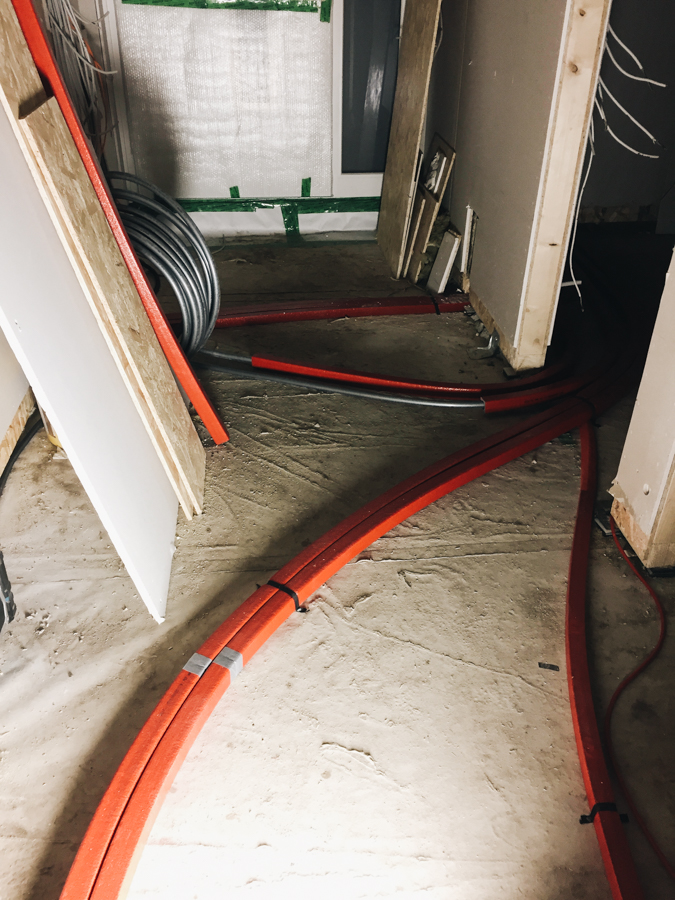

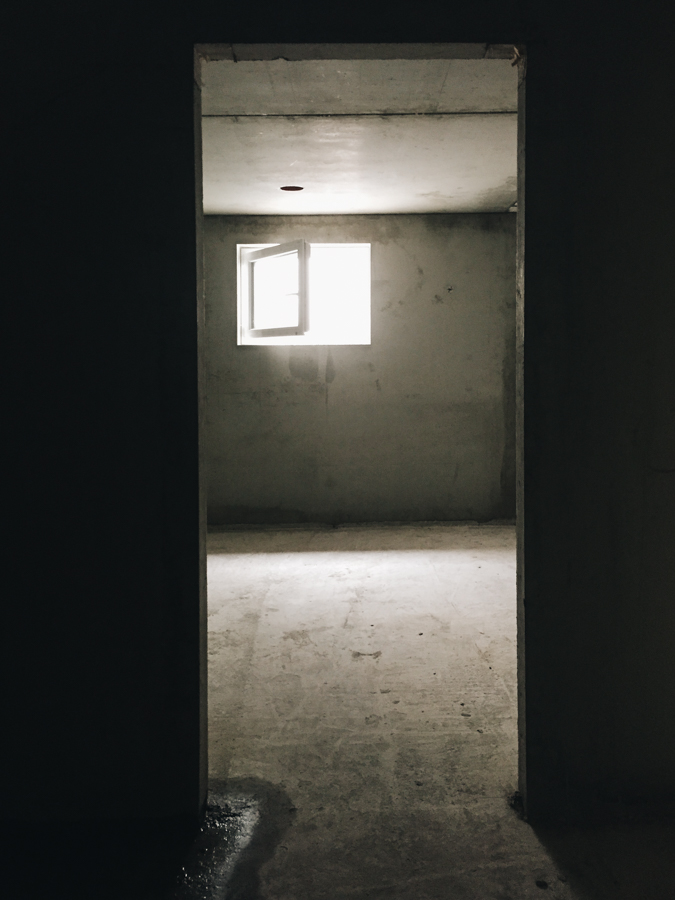

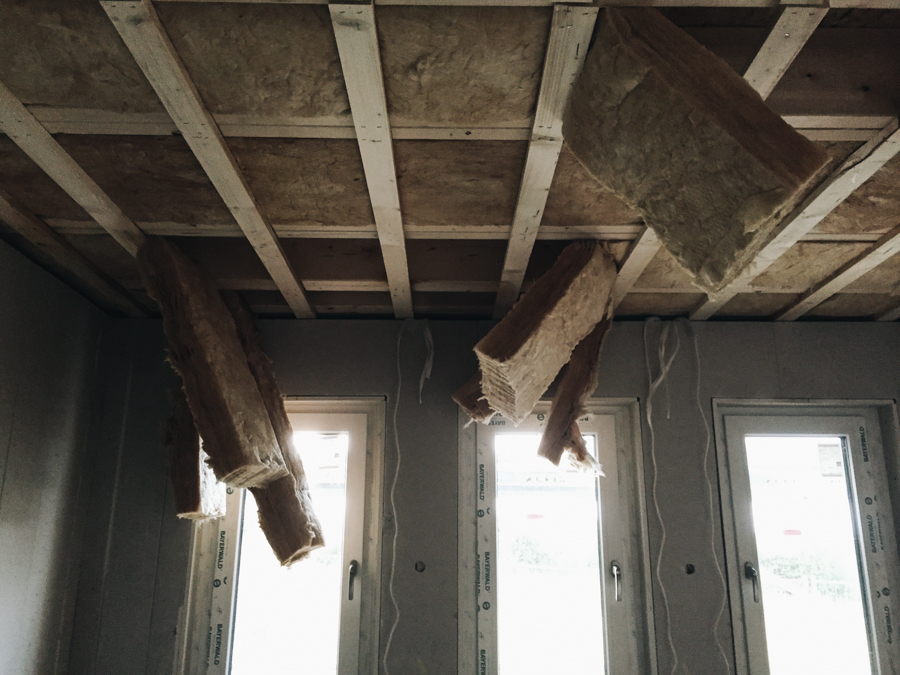

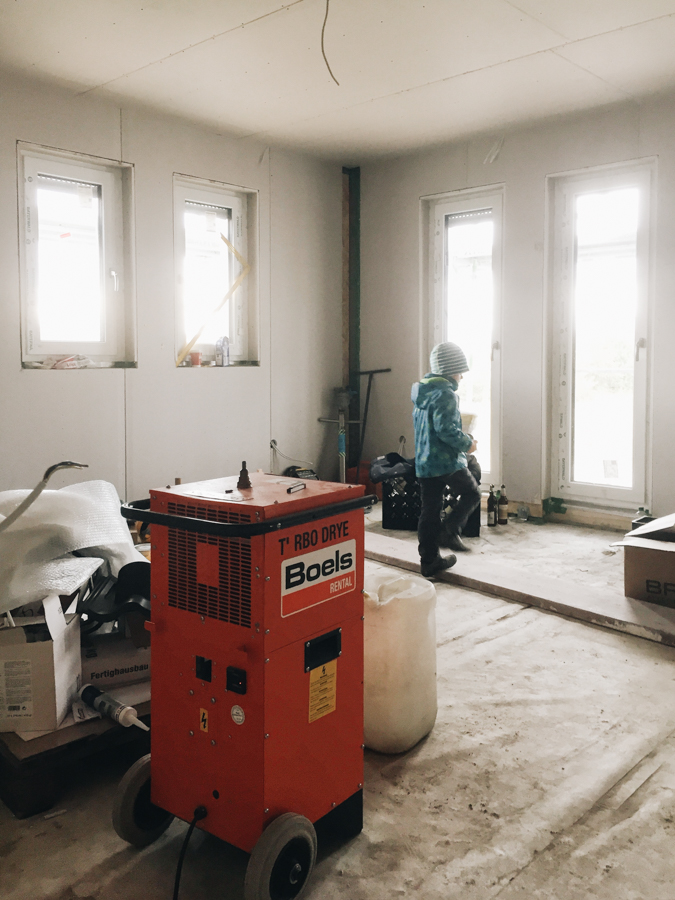

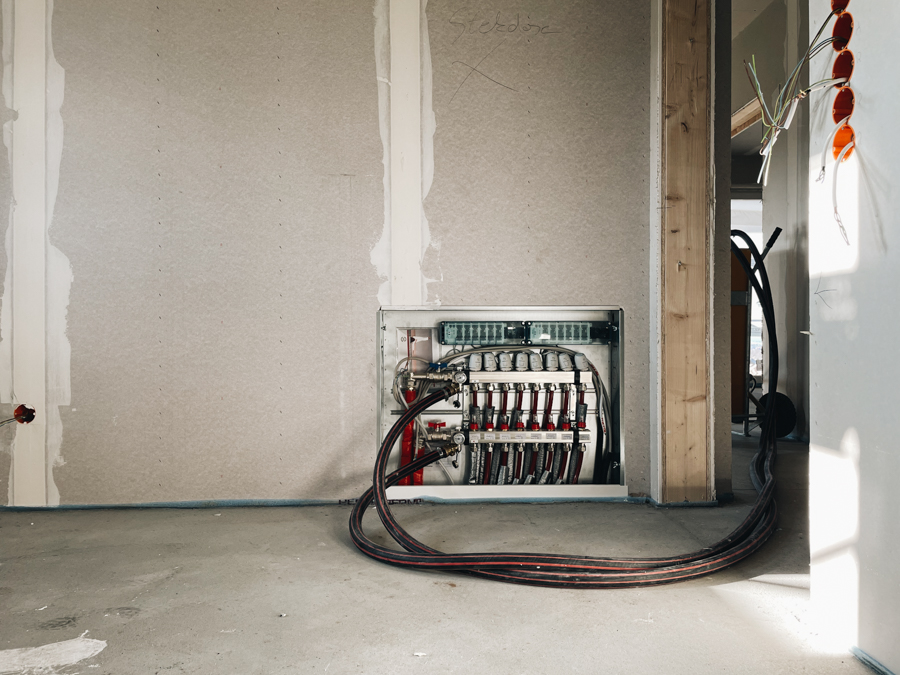

Oct 12, 2020: Drying machines are brought into position. The indoor installation is started. Electric cabling, heating, water.

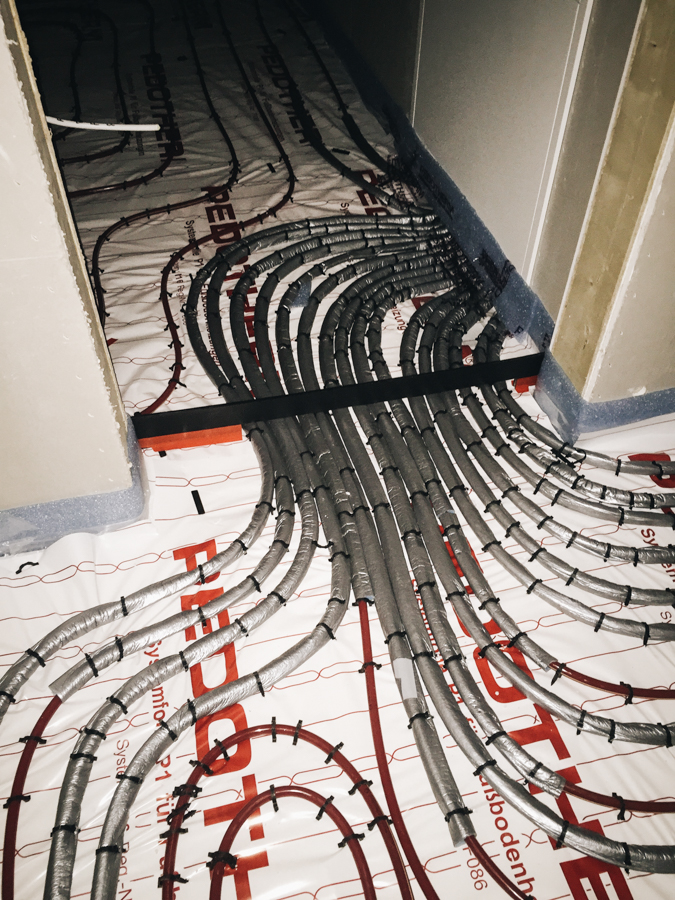

Nov 9, 2020: Screed on the floors. It´s now looking more and more like a future home.

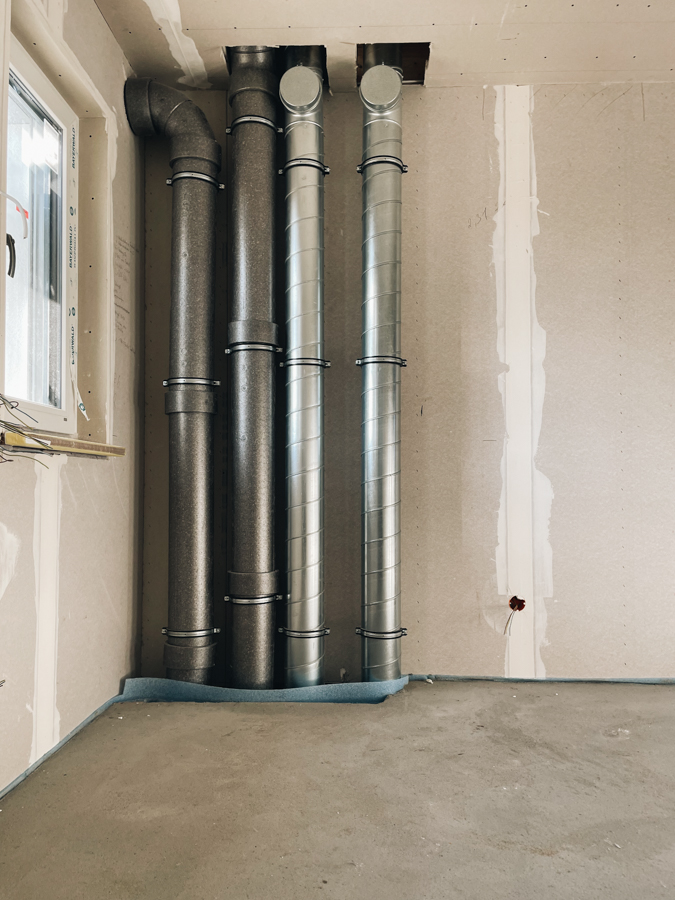

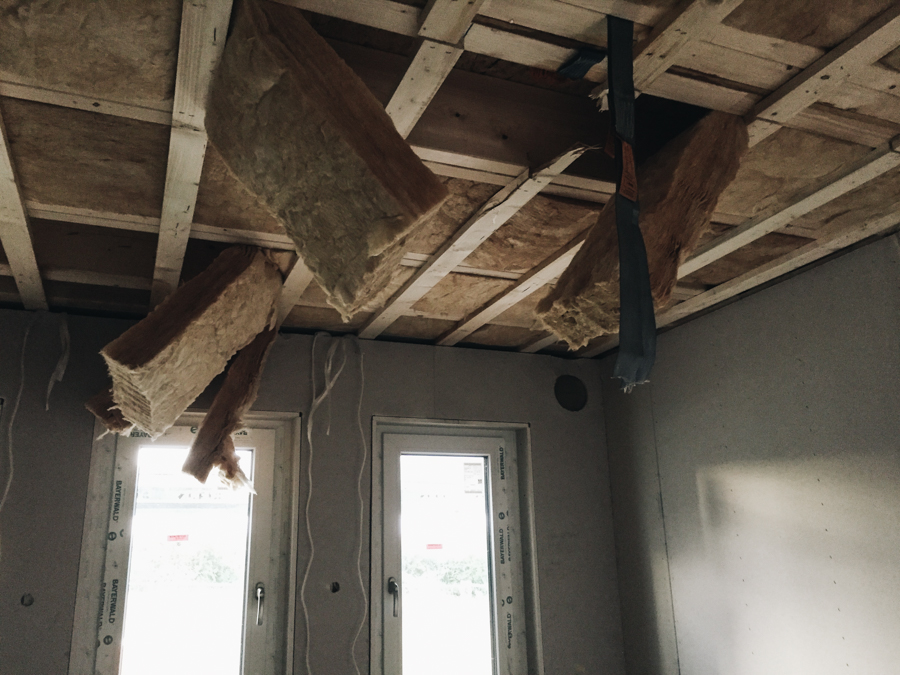

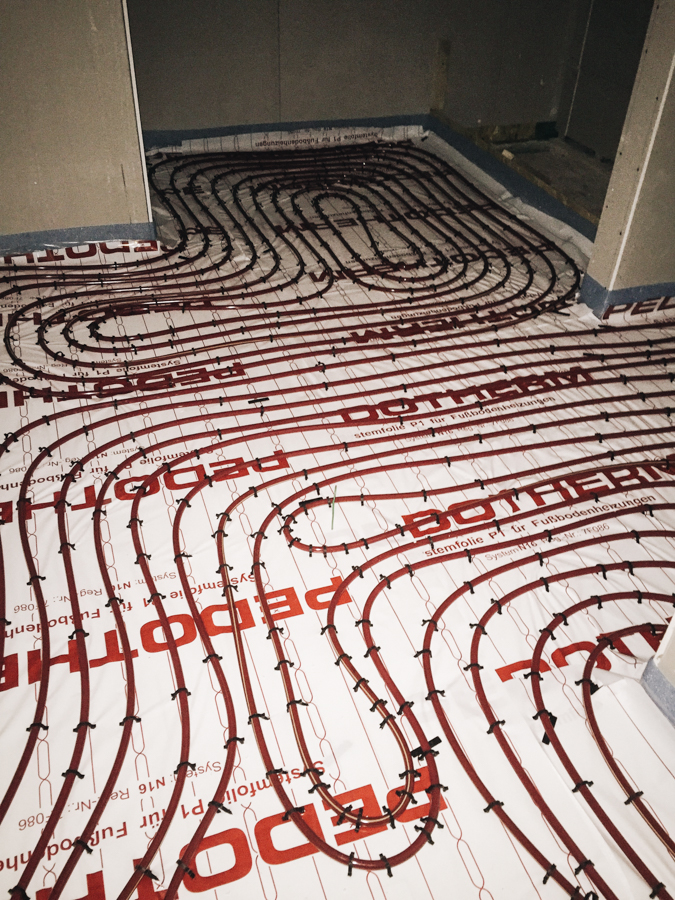

Central ventilation and heating

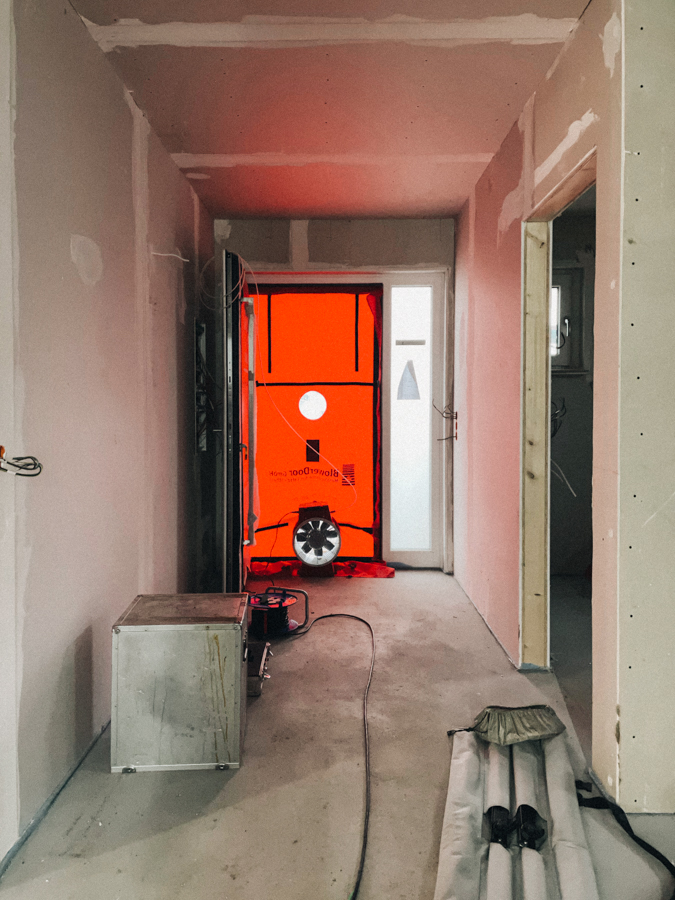

Dec 1, 2020: The blower door test. Everything is within tolerances.

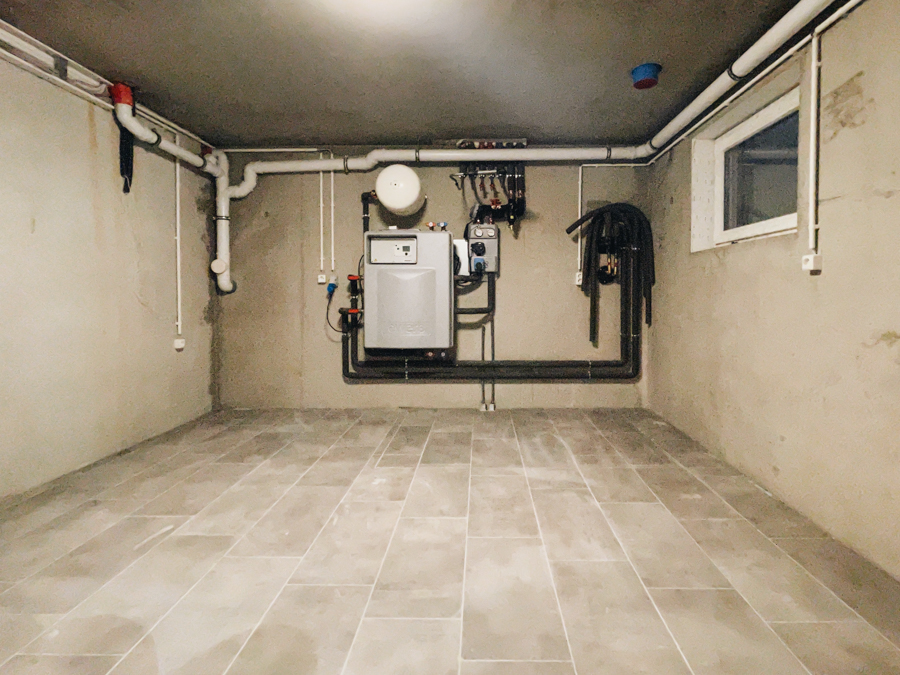

Dec 21, 2020: Our heating is installed.

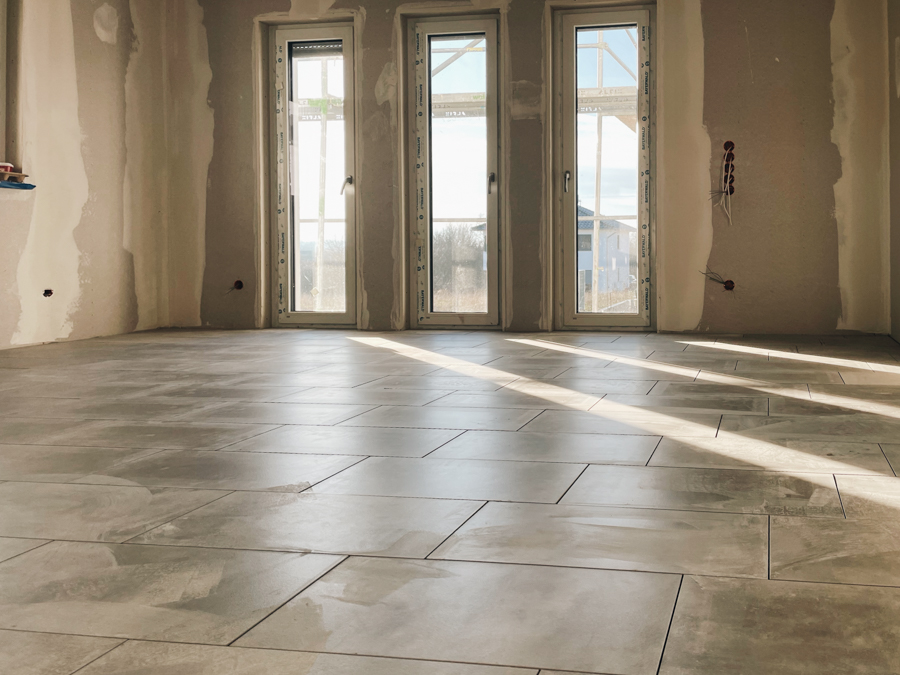

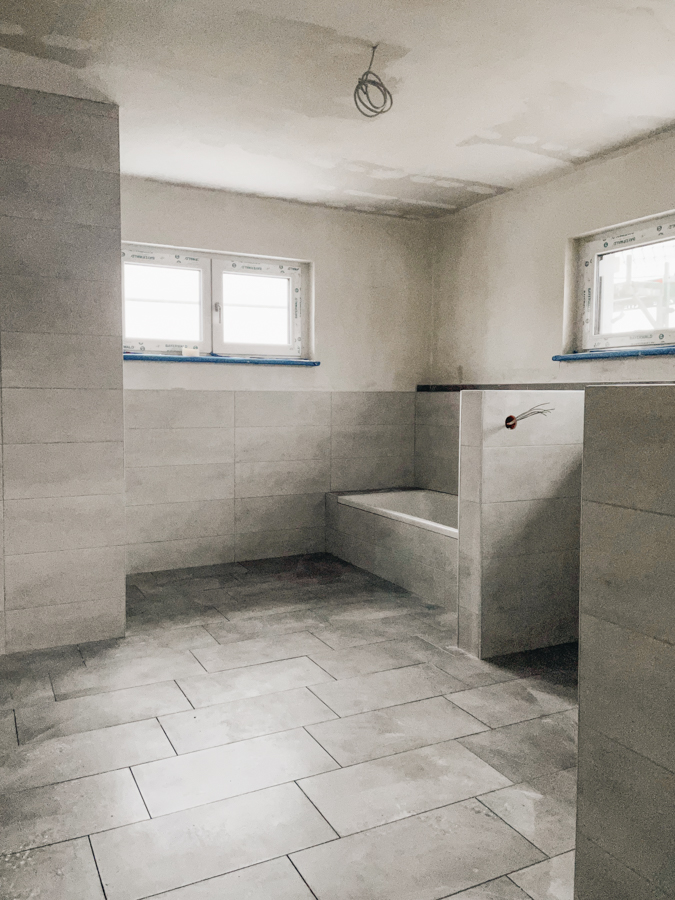

Dec 22, 2020: The craftsmen are doing an exceptional job with the laying of the tiles.

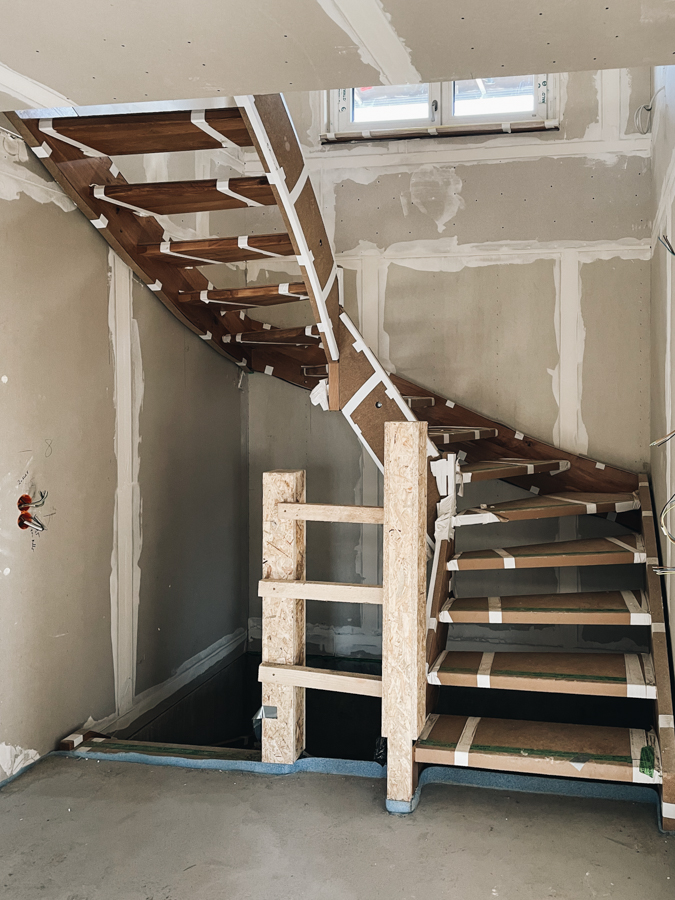

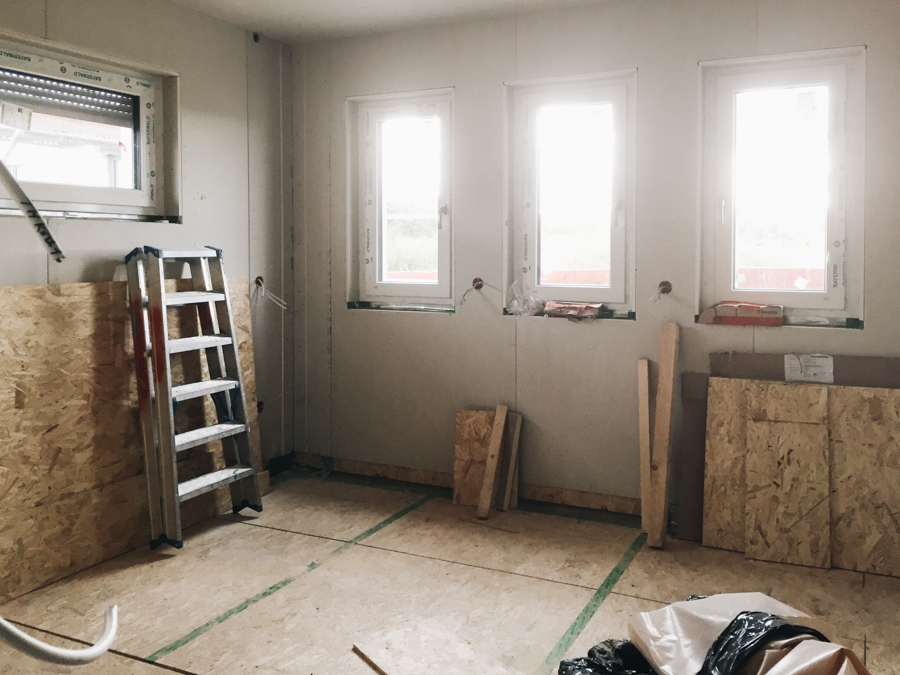

Jan 20, 2021: In the beginning decade of the home office, I will have my own :-).

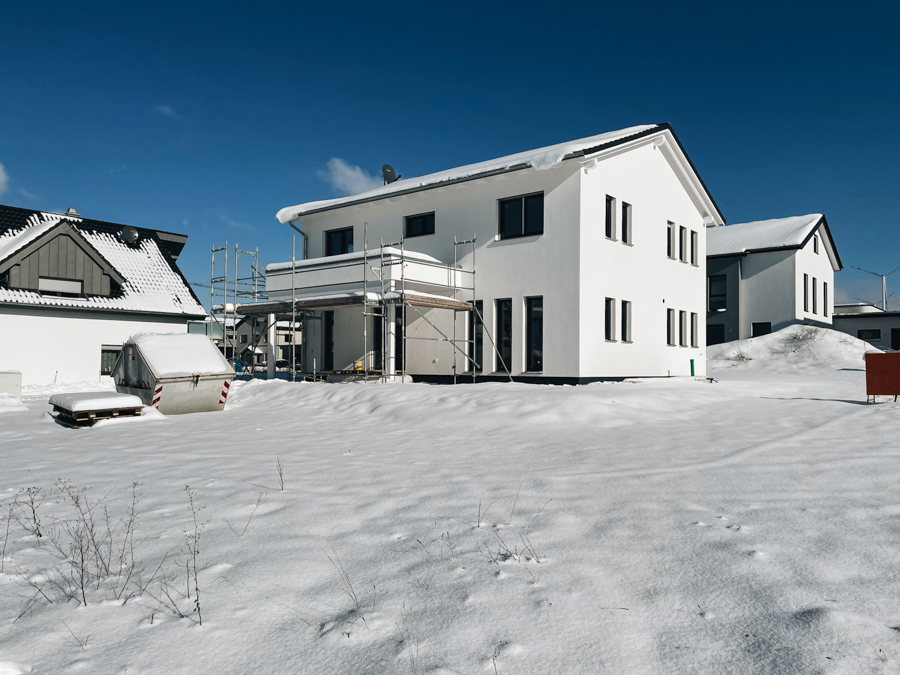

Feb 12, 2021: White in white during the very cold and snowy days beginning of February. We are close to the finish. Thankfully.
Mar 12, 2021: I cannot believe it, today we moved into the house. After the movers went into their weekend while wishing us the best, we bought some sushi from our preferred sushi cook Hakan (strongly recommended) and enjoyed just being there.
👌😊 I will have my own dedicated office-space. I cannot tell how much I was looking forward to this.
On a healthy diet with sushi and potato chips. Emil and I enjoy the peace.
Hakan, the founder of the excellent Edoki Sushibar , was responsible for our first meal in the new house.
May 27, 2021: Our two flat rooftops have been prepared to become green. See the growth process at The green rooftop

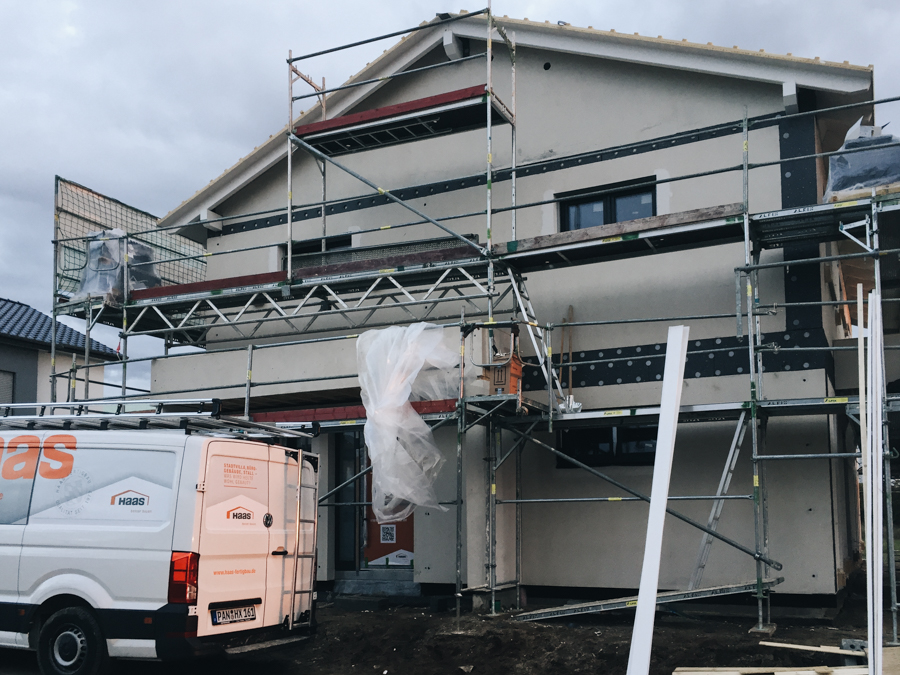

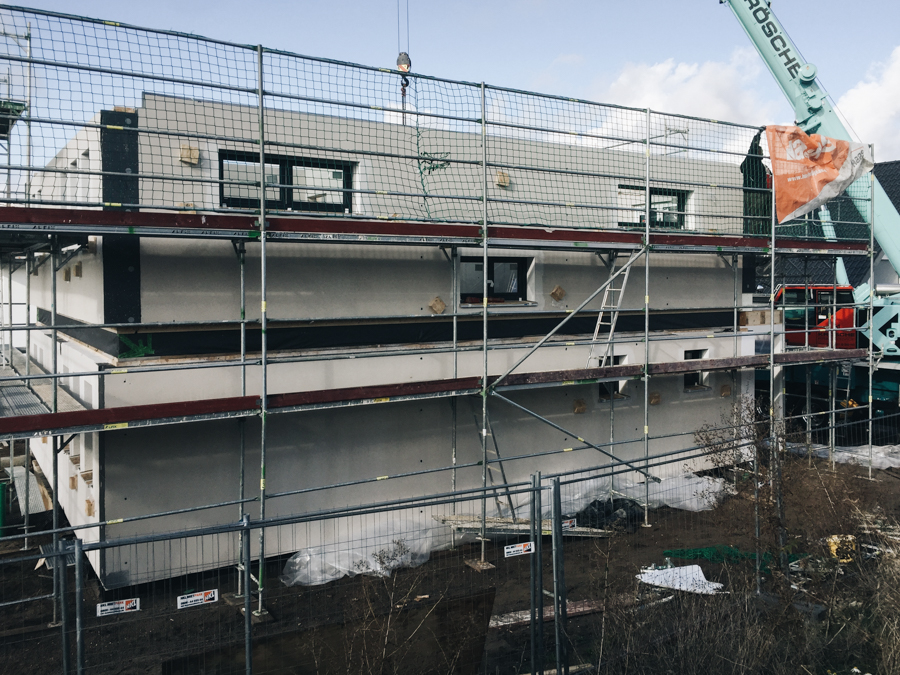

Jul 29, 2021: It´s the first time I see the house without any scaffolding. The pictures are made at dusk.
Nov 1, 2022: At the end of the summer we started to erect an angle retaining wall, filled everything up with soil, and planted a beech hedge.
